News introduction here...

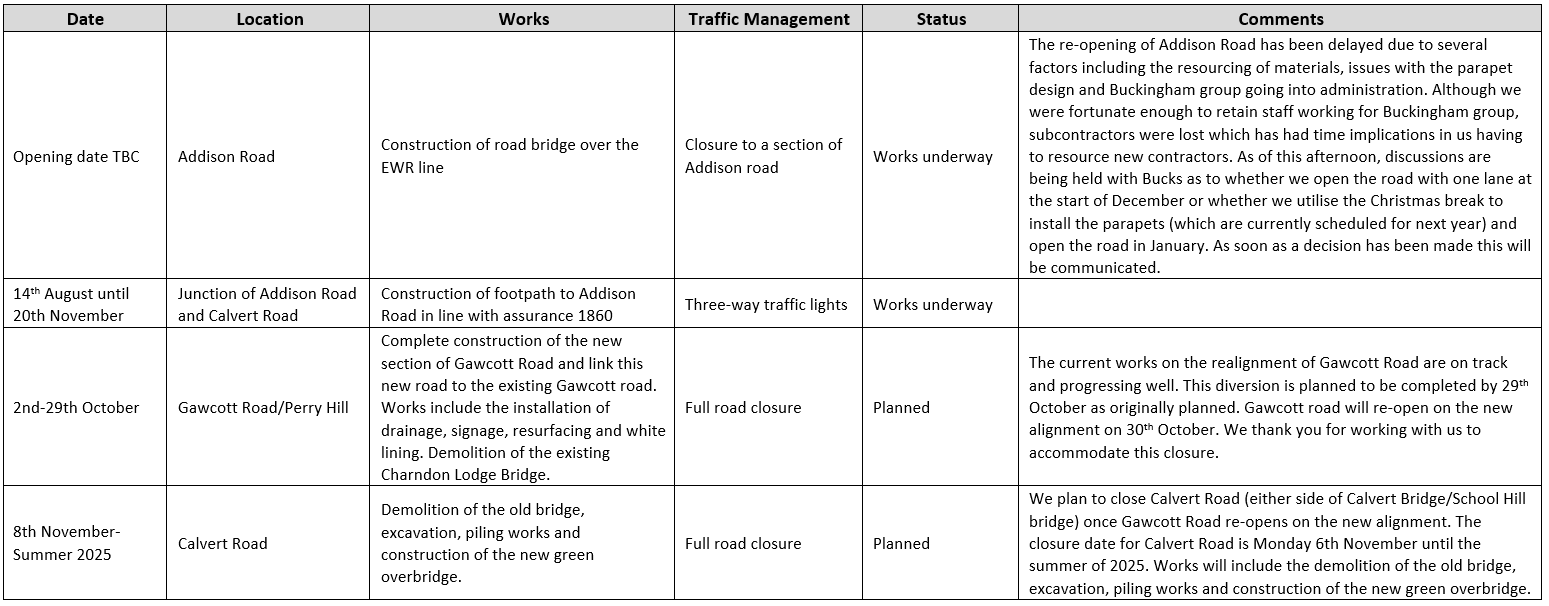

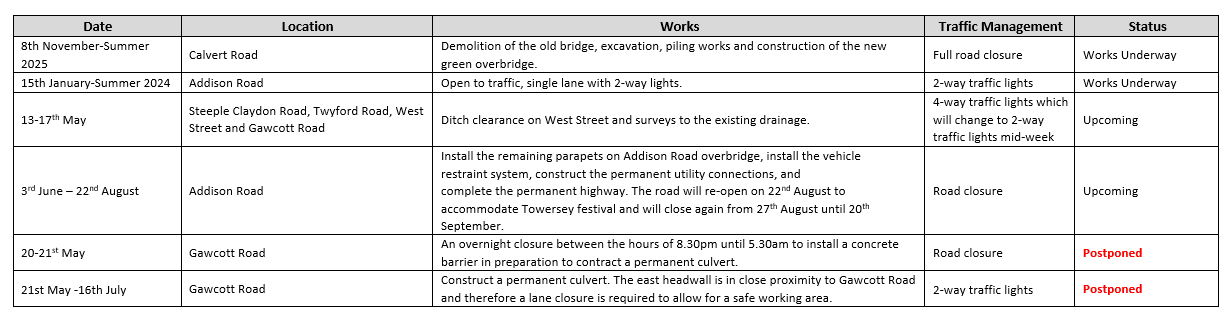

Update on HS2 4-way traffic lights

17
March 2024
Update on HS2 4-way traffic lights

Steeple Claydon Road, Twyford Road, West Street and Gawcott Road crossroads will nowbe under traffic management from Monday 5 February until Sunday 7 April 2024 near to the EKFB compound.
These dates may be subject to change due to circumstances, such as weather.
If you have a question about HS2 or its works, please contact the HS2 Helpdesk team on 08081 434 434 or email hs2enquiries@hs2.org.uk

East West Rail Alliance night works notification Feb 2024

21
February 2024
East West Rail Alliance night works notification Feb 2024

As the East West Rail project's track construction work comes to an end, they will be progressing onto finishing works. This includes operating trains to ensure that stability of the railway formation and track installation is achieved.Initially, thework will be carried out between Charbridge Lane, Bicester and Addison Road, Steeple Claydon. Following this, they will then be working from Addison Road, Steeple Claydon to Buckingham Road, Bletchley. To complete this stage of works, EWR will need to carry out the various activities.To be able to work safely, they will need to carry out these activities during the night to accommodate the programme. Regrettably, there may be some noise during the works, however, EWR will make every effort to keep the impact to a minimum.See attached letter for more details

Notice of Road Closure, Gawcott Road/Perry Hill

21
February 2024
Notice of Road Closure, Gawcott Road/Perry Hill

A section of Gawcott Road/Perry Hill will be closed from Monday 18 March until Sunday 7 April 2024.
There will be no access for Emergency services during this closure. Great Moor Sailing Club and the Calvert Jubilee Nature Reserve will be accessed from the South.
These dates may change due to conditions outside of HS2's control, such as weather. Please refer to the HS2 website regularly to check for any changes and updates.
If you have a question about HS2 or works, please contact theHS2 Helpdesk team on 08081 434 434 or email hs2enquiries@hs2.org.uk

HS2 Notice of Traffic Management Steeple Claydon Road, Twyford Road, West Street and Gawcott Road, 30 January-17 March

22
January 2024
HS2 Notice of Traffic Management Steeple Claydon Road, Twyford Road, West Street and Gawcott Road, 30 January-17 March

At the end of January 2024, EKFB will be carrying out some works on the temporary gas main diversion by completing some gas trial holes. These works are planned to be completed under 4-way lights.
To carry out these works safely and effectively, there will be traffic lights at the crossroads of Steeple Claydon Road, Twyford Road, West Street and Gawcott Road.
These works are an important step towards the re-alignment of Gawcott Road/Perry Hill over the new bridge, currently under construction.
Steeple Claydon Road, Twyford Road, West Street and Gawcott Road crossroads will be under traffic management from Tuesday 30 January until Sunday 17 March 2024 near to the EKFB compound.

Changes to household DIY waste disposal due from 31 December

18
December 2023
Changes to household DIY waste disposal due from 31 December

Residents in Buckinghamshire will be able to dispose of small amounts of DIY waste for free at Household Recycling Centres (HRCs) from 31 December 2023.

The changes have been brought in by central government and will make it easier for people to freely dispose of small amounts of waste created at home from DIY projects such as re-tiling, renovating a bathroom or digging a pond in the garden.

Today (Tuesday 12 December), Buckinghamshire Council’s Cabinet voted in favour of necessary changes to the council’s Waste Access & Acceptance Policy which sets out rules and procedures for the county’s 10 HRCs, to reflect the new legislation.

Following the change in law regarding the disposal of household DIY waste, the council is reintroducing a digital e-permit for DIY waste. From 31 December, any resident wanting to dispose of household DIY waste at a HRC will need to have an e-permit printed out or on a portable device, such as a mobile phone or tablet, before they visit. This only affects residents who wish to bring household DIY waste.

The DIY e-permit will allow residents to dispose of one load of DIY waste each week for free. One load of DIY waste is no more than 100 litres of loose DIY waste, or one large item no bigger than 2m x 0.75m x 0.7m such as one bath tub, one door or one kitchen unit. Staff will scan the permit and check the resident’s address, after which the e-permit will expire. It can be renewed after seven days, to allow residents to dispose of another load of DIY waste for free. Anyone wishing to dispose of more than one load of DIY waste in a week will be able to do so but will be charged, using the same price list which has been in place for the past four years.

Gareth Williams, Cabinet Member for Climate Change & Environment said: “We know these government changes will be welcomed by residents, but in order for us to manage them effectively, we are reintroducing a DIY e-permit system like we have used previously. This may be an extra step for residents, but it allows us to ensure that everything will run smoothly and will deter commercial traders from abusing the new system which is for residents only.”

Gareth continued: “We don’t want people to be held up in queues at the HRCs while the new system is bedding in, so we are looking to give people as much notice as possible of the changes and the need for them to download their e-permit before they visit the HRC from 31 December. We will be promoting the new process widely and would suggest people check our website and social media channels for the most up to date information. The whole process is very simple and straightforward and should become second nature to everyone once it has been up and running for a few weeks.”

The changes will only apply to DIY waste. Residents bringing garden waste, electricals, general and other types of waste commonly brought to HRCs will not be affected and can continue to use the sites in exactly the same way as before.

Commercial traders, landlords and residents disposing of waste produced by traders will still need to pay for commercial waste disposal.

For more information on the changes visit the council website.

One load_Free allocation_Landscape

HRC 1

EKFB HS2 Autumn Newsletter

19
November 2023
EKFB HS2 Autumn Newsletter

Attached is the Calvert Area HS2 Update Autumn Newsletter

If you have any questions or enquiries regarding HS2 works, please contact the HS2 Helpdesk - details of which can be found in this newsletter.

You can also sign up for regular updates in your local area at www.hs2inyourarea.co.uk.

HS2 drop in event at Calvert Green Village Hall

19
November 2023
HS2 drop in event at Calvert Green Village Hall

EKFB (HS2 main contractor) is hosting a community drop-in event at Calvert Green Community Centre on Wednesday 22nd November between 4pm and 7pm.

It's an opportunity to find out about the works taking place at Calvert Railway Bridge, speak to the team to discuss our progress so far; and see maps and plans of the project.

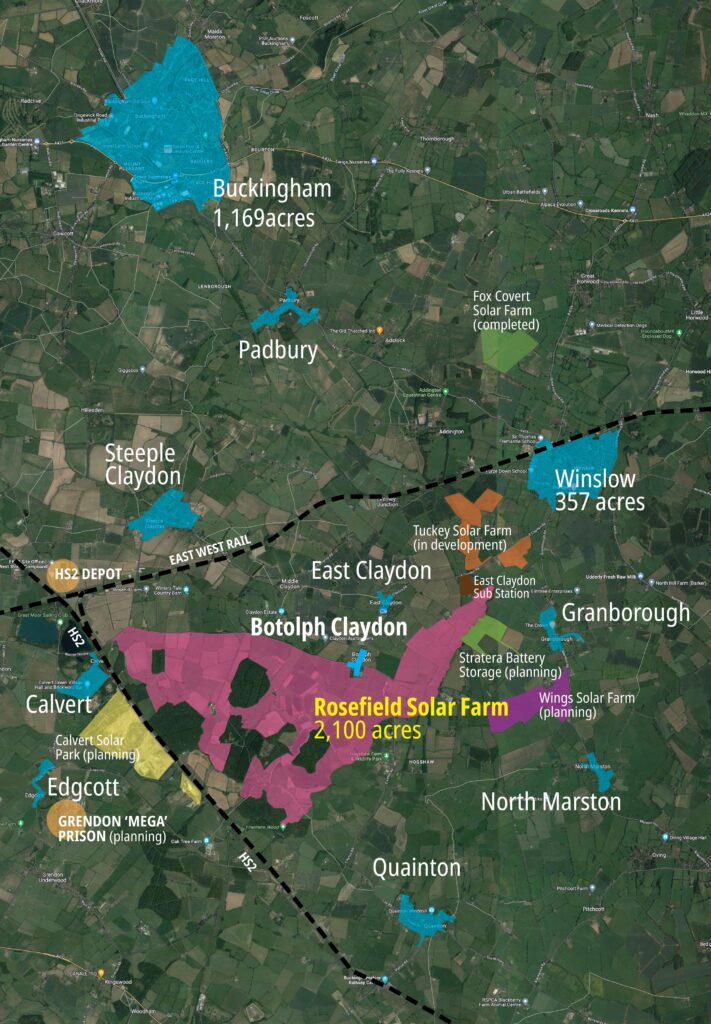

Rosefield Solar Farm Proposal

29
October 2023
Rosefield Solar Farm Proposal

Although the Parish Council has previously supported solar farm applications in the area, it was decided at the last parish council meeting that we will oppose the Rosefield Solar Farm scheme due to its size, the commulative impact and disruption to our local area (in addition to the existing projects), and the impact on tenant farmers and loss of farming land in the area.Everyone is entitled to their own view on this scheme and there is a consultation open to everyone at www.rosehillsolarfarm.co.uk. There is also a public exhibition at calvert Green community hall this Wednesday between 5pm and 8pm.There is a local action group who have a website: https://claydonssolaractiongroup.co.uk/ and has some very useful facts and figures. They are also keen for volunteers to help.

Calvert Railway Bridge Closure for 2 years

21
October 2023
Calvert Railway Bridge Closure for 2 years

There is no easy way to dress this up - Calvert Railway Bridge will be closed from 8th November 2023 until Summer 2025. This is while the existing bridge is demolished and a new bridge is constructed. This has been known about for 10 years, but the date has only just been confirmed by EKFB, HS2's main contractor.

The main Edgcott to Gawcott Road will be reopened when the bridge is closed, but it is likely that Addison Road will not open until late December 2023.

EKFB is planning a ‘drop in’ village hall event next month in Calvert Green to provide information on works taking place at Calvert Railway bridge following the closure of Calvert Road. More details will follow, but we have asked that it is late afternoon/evening.

A more detailed document covering the road closure is attached.

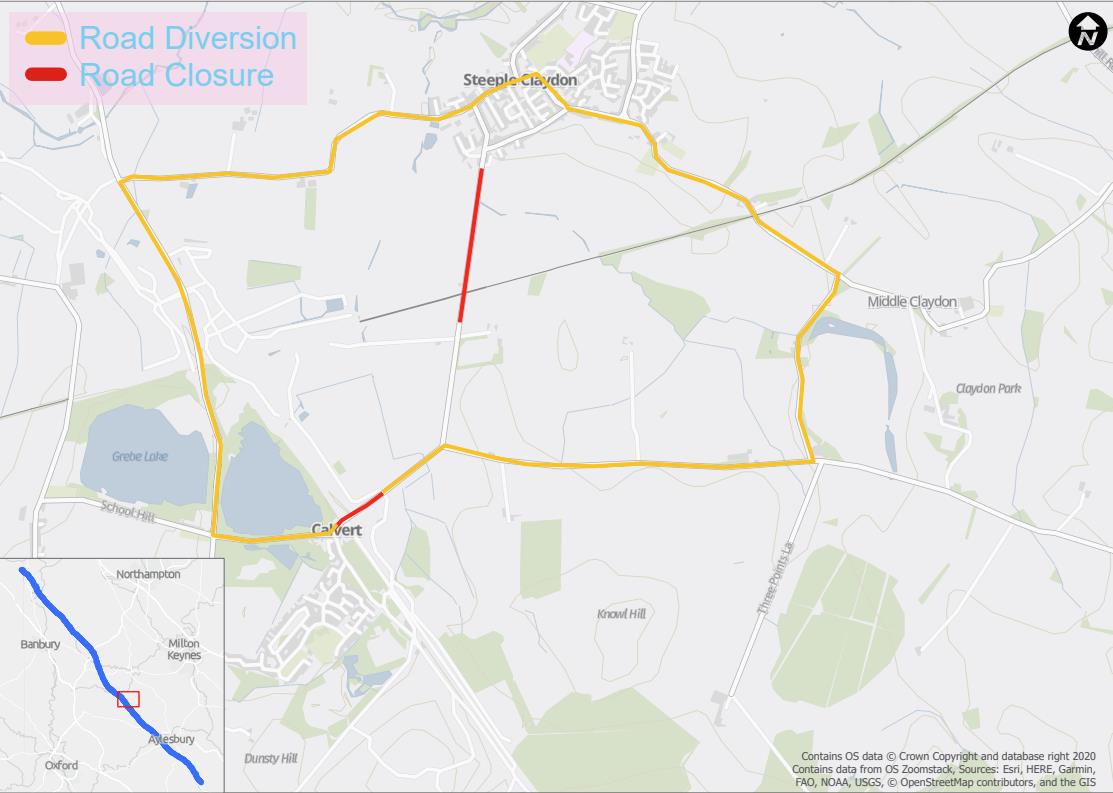

Notice of Road Closure Calvert Road Calvert - 08 Nov 23.jpg

Parish council HS2 site visit

20
October 2023
Parish council HS2 site visit

On 20th October, Cllr Blakely and Cllr Gaskin visited the EKFB West Street compound and were given a tour of the HS2 works which included viewing the location of the proposed bat mitigation structure alongside Sheephouse Wood, the new bridge on Addison Road, the location of the bentonite storage, and the future HS2 overbridge which will replace the current road alignment on the Gawcott to Edgcott road. Here are some photographs taken during the visit.

HS2 Gawcott Road Closure in October

28
September 2023
HS2 Gawcott Road Closure in October

HS2 CALM Meeting 28092023

28
September 2023
HS2 CALM Meeting 28092023

Rosefield Solar Farm Proposal

15
September 2023
Rosefield Solar Farm Proposal

HS2 Notice of Public Right of Way closure, Steeple Claydon July 2023

16
July 2023
HS2 Notice of Public Right of Way closure, Steeple Claydon July 2023

Chairman's report 2023

Chairman's report 2023
30
May 2023
Chairman's report 2023

HS2 Road Works near the Great Moor Sailing Club and near the EKFB Compound entrance

22
May 2023
HS2 Road Works near the Great Moor Sailing Club and near the EKFB Compound entrance

Please see attached a copy of the HS2 Advance Works Notice for 2 sets of traffic lights which will be in place near the Great Moor Sailing Club and near the EKFB Compound entrance. These will be in place from 30 May to 18 June.

Notice of Traffic Management, Gawcott Road/Perry Hill

05
May 2023
Notice of Traffic Management, Gawcott Road/Perry Hill

Notice of Road Closure Gawcott Road Perry Hill

17
March 2023
Notice of Road Closure Gawcott Road Perry Hill

Unfortunately, further bad news. The Edgcott to Gawcott road will be closed from Charndon Crossroads to the seven stars cross roads. See attached PDF

EKFB/HS2 Noise Vibration Presentation

14
March 2023
EKFB/HS2 Noise Vibration Presentation

Attached is a recent presentation delivered by EKFB which covers noise and vibration monitoring and impacts in our area.

Upcoming Traffic Management on Gawcott Road/Perry Hill from Monday 20 March to Early April 2023

06
March 2023
Upcoming Traffic Management on Gawcott Road/Perry Hill from Monday 20 March to Early April 2023

Two sections of Gawcott Road/Perry Hill will be under 2-way traffic lights from Monday 20 March until early April 2023.
A third section of Gawcott Road/Perry Hill will be under 4-way traffic lights from Monday 27 March until early April 2023.

Please see attached PDF file for more details.

Contact the HS2 Helpdesk team all day, every day of the year on:
Freephone: 08081 434 434
Minicom: 08081 456 472
Email: hs2enquiries@hs2.org.uk

To keep up to date with what is happening in your local area, visit: www.hs2inyourarea.co.uk

HS2/EKFB Bat Structure sessions

05
March 2023
HS2/EKFB Bat Structure sessions

EKFB (HS2 contractor) will be hosting a virtual and face-to-face session on the bat mitigtaion structure near Sheephouse Wood in our area:

  • You Said, We Did online webinar – 8th March 6pm-7pm
  • Calvert Green Village Hall Event – 15th March 3pm-7pm

More details are in the attached PDF

BBC in Calvert to cover HS2 noise and vibration

23
February 2023
BBC in Calvert to cover HS2 noise and vibration

The BBC will be in Calvert tomorrow (Friday 24th February) to cover noise and vibration because several properties have already suffered issues from construction even though works aren't close yet.If you have been affected or are around and would like to show support, please feel free to join us at the junction of Brackley Lane and Werner Terrace at 12pm tomorrow.As a bit of history, HS2 was alerted to vibration concerns over 10 years ago and have constantly dismissed it. Despite promises, vibration monitoring was only installed last week.We hope to see you tomorrow (and sorry for the short notice).

HS2 drop in sessions

02
February 2023
HS2 drop in sessions

HS2 and EKFB have three upcoming community drop in event:

  • Calvert Green Village Hall – Wednesday 15th February from 3.30-7.30pm
  • Twyford Village Hall – Wednesday 22nd February from 5-8pm
  • Steeple Claydon Village Hall – Tuesday 28th February from 5-8pm
These events will be inside the village halls and HS2/EKFB representatives will be on had to answer any questions

Latest HS2 roadworks/road closures in our area

02
February 2023
Latest HS2 roadworks/road closures in our area

Notice of Road Closures, West Street, Steeple Claydon to Twyford Area and Gawcott Road/Perry Hill

If you have any questions, contact the HS2 Helpdesk team all day, every day of the year on:
Freephone 08081 434 434
Minicom 08081 456 472
Email hs2enquiries@hs2.org.uk

HS2 Calvert North Newsletter - January 2023

18
January 2023
HS2 Calvert North Newsletter - January 2023

Please see attached HS2 Calvert North winter newsletter

For any queries or complaints about HS2, please contact then using one of the methods below:
Freephone: 08081 434 434
Minicom: 08081 456 472
Email: hs2enquiries@hs2.org.uk
Website: www.hs2.org.uk
To keep up to date with what is happening in your local area, visit: www.hs2inyourarea.co.uk

Communities and Localism Select Committee Meeting

17
January 2023
Communities and Localism Select Committee Meeting

Communities and Localism Select Committee Meeting

On 17 January, senior representatives of HS2 and EWR attended Buckinghamshire Council’s Communities and Localism Select Committee to report on how they are engaging with communities impacted by the construction works. At the meeting were Mark Cuzner, EWR Director, Thaina Sa’id EWR Community Officer, Rohan Perrin HS2 Project Client Director, Maddelyn Sutton, Head of Engagement HS2, Simon Matthews EKFB Interface and Stakeholder Director, Michael Eckett Head of Acquisition HS2, and Elena Gonzalez Social Value and Legacy Manager at EKFB, Cllr Peter Martin Deputy Cabinet Member for HS2/EWR and Buckinghamshire Councillors representing their communities.

EWR and HS2 gave presentations and responded to questions by members of the public and Buckinghamshire Councillors.

The discussions were frank and open with both criticisms and praise of the projects’ actions and communications. One of the main issues discussed with EWR was a community project to build a car park for the East Claydon School, which has not been properly delivered to date. Although EWR have invested a lot of time and money on the project, the car park is still not fit for purpose due to issues with the drainage. In the end it was decided that EWR and HS2 would look together at how they could rectify the situation to the satisfaction of the Members and the community.

Other issues raised included lack of warning regarding road closures and diversions, HGV road damage, poor advance notice of community engagement events, vibration damage to houses in the Calvert area, failure of EWR and HS2 to work closely together to relieve the impact on residents, and the height of the bridge in Marsh Gibbon affecting a local business. There was some positive feedback about the creation of a haul road in Chalfont St Peter to save HGVs driving through the narrow village lanes, the early opening of public rights of way, and jobs being given by HS2 to those previously unemployed.

Councillors raised concerns about the level of engagement and communication for Buckinghamshire residents, including those who live a little further away from the construction route, such as Wing and Bourne End, but are affected by the impact of works as they go about their daily activities.

Maddelyn Sutton, Head of Engagement HS2, said she they will increase communications to communities and Councillors further from the rail line and proposed bringing the EKFB mobile visitor centre to the next full Council Meeting.

You can watch the video recording here

HS2 Mobile Visitor Centre at the top of Brackley Lane on Thursday 26th January 2023

Calvert Green Community Centre
17
January 2023
HS2 Mobile Visitor Centre at the top of Brackley Lane on Thursday 26th January 2023

Please see attached document regarding HS2 mobile visitor centre visit to the site of the demolished houses at the top of Brackley Lane (by the railway bridge) on Thursday 26th January 2023, between 16:00 and 18:00

For any queries or complaints about HS2, please contact then using one of the methods below:
Freephone: 08081 434 434
Minicom: 08081 456 472
Email: hs2enquiries@hs2.org.uk
Website: www.hs2.org.uk
To keep up to date with what is happening in your local area, visit: www.hs2inyourarea.co.uk

HS2 Gawcott Road/Perry Hill closure

16
January 2023
HS2 Gawcott Road/Perry Hill closure

Further to the previous HS2 update on 12th December, the Gawcott Road/Perry Hill closure will be re-instated from Monday 16th January – Monday 6th March 2023.
This will be a full closure, 24 hours a day.

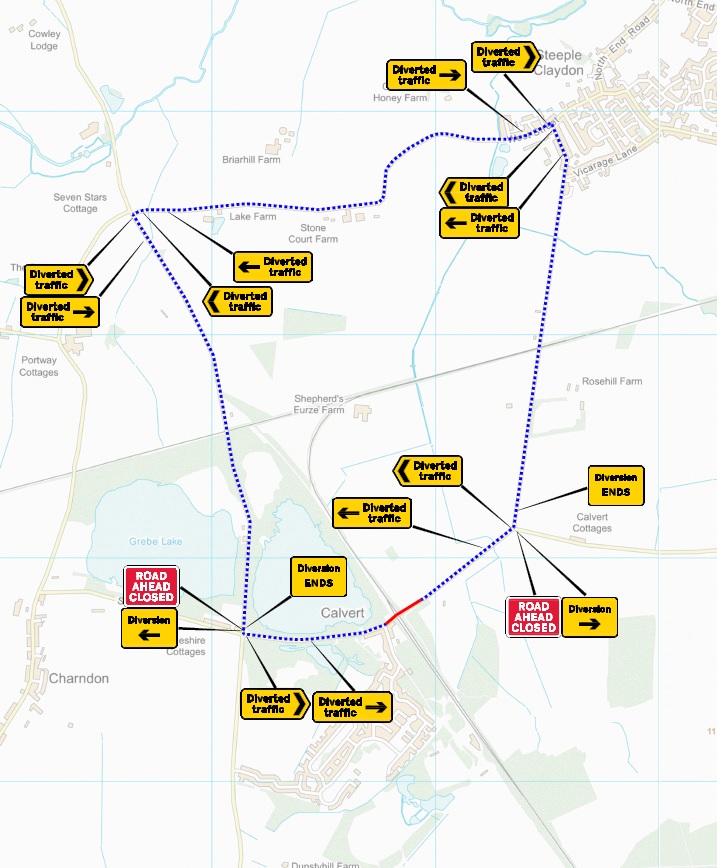

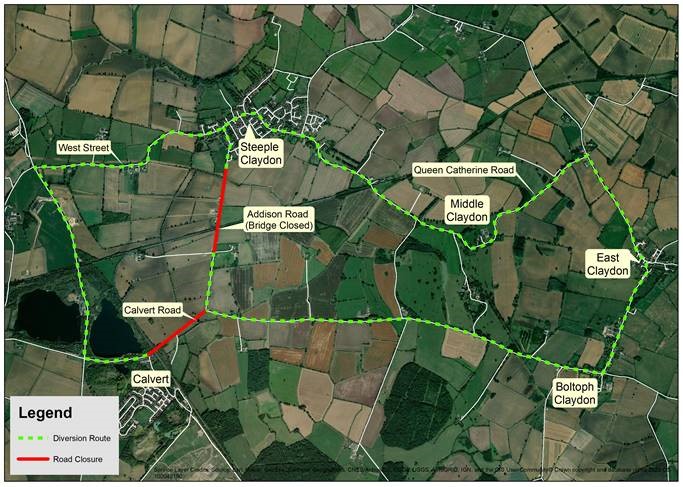

Please see the map showing the diversion route.

For any queries or complaints about HS2, please contact then using one of the methods below:
Freephone: 08081 434 434
Minicom: 08081 456 472
Email: hs2enquiries@hs2.org.uk
Website: www.hs2.org.uk
To keep up to date with what is happening in your local area, visit: www.hs2inyourarea.co.uk

Are you winter ready? - Press release from Buckinghamshire Council

14
November 2022
Are you winter ready? - Press release from Buckinghamshire Council

Are you winter ready?

Press release from Buckinghamshire Council

Buckinghamshire Council is encouraging residents to plan and prepare for the cold season with some helpful tips for staying safe and warm.

While winter is fast approaching, snow, ice, storms, heavy rain and high winds could be just around the corner. The council wants all residents to be thinking about what they can do to stay safe in these challenging conditions, including where to get support and how to report any winter-related issues.

One of the best things you can do to be prepared is to create an Emergency Plan for your household.

Having a household plan can help you deal quickly and effectively in a stressful situation. Involving your family/household in thinking through a plan can also help them be prepared.

Ask yourself and your family ‘what if?’ questions, and then find the answers. Also think about emergency friends, important contacts and how people would know your needs in an emergency.

The council has some excellent support webpages around this. Visit their Planning for Emergencies pages to pages to find tips on creating an Emergency Plan for your household, what you should have in your emergency ‘grab bag’ and much more.

Other #WinterReady tips from the council include:

  • Check whether you are on a gritting route.
  • Report a flooded or icy road via FixMyStreet.
  • Try and heat the rooms you use to at least 18°C if you can, particularly if you have reduced mobility, are 65 and over, or have a health condition such as heart or lung disease.

Steve Bowles, Cabinet Member for Communities, said:

“The key focus on being winter ready is planning. We want our residents to plan rather than worry unnecessarily about snow, ice and winter storms.

“You can do this by asking yourself questions such as: Do you know where your wellies are if it floods? Do your children know whose house to go to if the roads are blocked after school? Have you checked the batteries for your torch if there is a power cut?

“By thinking ahead and having a plan of action – we can all be winter ready.”

Next 4 weeks of HS2 roadworks in the area

30
October 2022

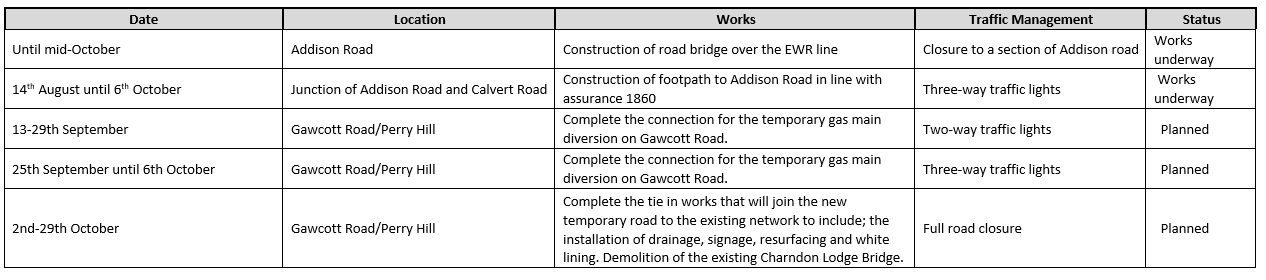

Next 4 weeks of HS2 roadworks in the area

Notice of HS2 Roadworks in Calvert

28
October 2022
Notice of HS2 Roadworks in Calvert

An update regarding works in the Brackley lane / Werner terrace area. Advanced works notice attached.

The key points to note are that:

  • There will be some night time road closures week commencing 7th November. The closures will be from 8pm to 6am and are required for our survey team to carry out topographic surveys.
  • The works is being done in two phases – nights of the 7th, 8th and 9th of November will involve the Werner Terrace / School hill section. The night of the 10th and 11th will be Brackley Lane.
  • Residents access will be maintained to properties and the parking area at the back of Werner terrace and the road closures will have operators at the closure points. Ideally it would be best if vehicles were not on the highway section of the closures.
  • These works have been coordinated so they do not conflict with other road closures in the area.

You can contact the HS2 Helpdesk team all day, every day of the year on:

Freephone 08081 434 434

Minicom 08081 456 472

Email hs2enquiries@hs2.org.uk

Write to: FREEPOST, HS2 Community Engagement

Website www.hs2.org.uk

To keep up to date with what is happening in your local area, visit: www.hs2inyourarea.co.uk

Update on Gawcott Road / Perry Hill Closure

22
October 2022
Update on Gawcott Road / Perry Hill Closure

We have just been informed that the planned closure of the section of Gawcott road / Perry Hill that was due to take place is being delayed by around two weeks.The junction improvement works have been completed at the junction in Charndon though the pedestrian lights and traffic lights are not yet in place. They should be in place this week and once in place an in operation the section of School Hill can be fully opened.

HS2 road closure updates

20
October 2022
HS2 road closure updates

Here is an update on the planned road closure to a section of Gawcott road / Perry Hill in line with the earlier communication in the PDF.

It is planned to close the section of Gawcott road / Perry Hill shown on the attached Notice (between the Charndon cross roads passed the sailing club) on Thursday 27th October.

 Please note the following:

  1. The improvement works to the junction by Charndon have been carried out and traffic lights are to be installed early next week, This junction will become a three way / two phase traffic light junction to manage the traffic flow. Safety improvements to the junction have been carried out and a pedestrian crossing will be in place.
  2. Traffic lights will also be installed at the bridge that crosses the EWR line that is narrow. This will mean that single lane traffic will cross the bridge.
  3. HS2 HGV’s will not use the diversion route and will only use the existing routes that they use.

  4. Access to Calvert Jubilee and the sailing club will be maintained and communication with these organisations is taking place separately/ Other stakeholders such as Langston and Tasker / Claydon House are being informed separately.
  5. It has been requested that HS2 does a drive through of the diversion route with a large vehicle to provide confidence that the diversion route is workable. The diversion route has passed the necessary safety assessments and is considered suitable and we are seeing if this can be arranged early next week.
  6. Advanced notice signs are also being set up along the road so that closure is visible to road users over the coming week.

Road works and road closures over Calvert Bridge

19
October 2022
Road works and road closures over Calvert Bridge

From today, EKFB (on behalf of HS2) will be doing some work on Brackley lane that involves traffic lights for a couple of days. they will also will be doing some work next week that involves night-time closures for topographic surveys and CCTV of the drainage system. During these works access will be provided to frontages / residents as well as emergency services.

Traffic lights over the next couple of days at the Brackley Lane / Werner Terrace Junction

A section of School Hill / Werner Terrace will be closed overnight for 3 nights beginning Monday 24 October 2022.

A section of Brackley Lane will be closed overnight for two nights in late October beginning Thursday 27 October 2022.

Early works for the construction of School Hill Bridge commenced in August 2022 and will continue throughout the autumn and winter.

Normal working hours: Monday to Friday 8.00am – 6.00pm, Saturdays 8.00am – 1.00pm
Overnight working hours: 8.00pm – 6.00am

Contact the HS2 Helpdesk team all day, every day of the year on:
Freephone 08081 434 434
Minicom 08081 456 472
Email hs2enquiries@hs2.org.uk

To keep up to date with what is happening in our local area, visit: www.hs2inyourarea.co.uk

New home energy schemes for Bucks residents

07
October 2022
New home energy schemes for Bucks residents

Hundreds of households in Buckinghamshire are set to benefit from new funding to make their homes more energy efficient as part of a joint project paid for by Central Government funding.
The news will be welcomed by households across the county, many of whom are at risk of being pushed into fuel poverty due to rising fuel costs.
The grants are for households with a gross annual income of less than £30,000 or who are receiving eligible benefits, and properties must have an energy rating of D, E, F or G.
The scheme will benefit both homeowners and those who rent privately. The new grant funding will potentially help more than 400 households in the county, and includes properties that are ‘off grid’, currently using an alternative energy supply, such as oil.
For owner occupiers, the work will be carried out for free. However, for rental properties (whether private or social), the landlord will be expected to pay at least one third of the cost towards the work.

EWR road works on Sandhill Road October - November 2022

01
October 2022
EWR road works on Sandhill Road October - November 2022

Western Power Distribution will be working on behalf of East West Rail Alliance to carry out the installation of electrical power works. These works will be a part of our Signalling,
Power & Communication infrastructure and are key for maintenance and functioning, once the East West railway is operational.
These works will start from 3rd October 2022 to 4th November 2022.

New Date for HS2 bat structure event in Calvert

30
September 2022
New Date for HS2 bat structure event in Calvert

On behalf of HS2, EKFB is hosting a public drop-in event at Calvert Green Village Hall on Wednesday 5th October between 3pm and 7pm.
If you are unable to attend in person, there will be an online event on Monday evening 3 October 6pm-7pm.

The focus of this event is the £40m+ bat mitigation structure by Sheephouse Wood (near the incinerator) https://www.bucksherald.co.uk/news/people/ps40m-hs2-bat-tunnel-will-come-too-late-for-rare-mammal-colony-in-aylesbury-vale-3662439. Sadly they won't be building a tunnel to protect local residents

The below PDF contains information on how to access material and register for the online event, along with general contact details for HS2.

Notice of HS2 works and road closures in the Twyford and Charndon area

26
September 2022
Notice of HS2 works and road closures in the Twyford and Charndon area

During Autumn 2022, EKFB will becarrying out highway safety improvement works on behalf of HS2 to the School Hill and Main Street Junction and beginning construction on the permanent realignment of Gawcott Road, also known as Perry Hill.
The safety improvement works being carried out to the School Hill / Main Street Junction consist of alterations to footpaths, the provision of barrier fencing and installation of a pedestrian crossing. These works are due to begin in early October.
During this period, there will be temporary traffic management in the form of a lane closure with traffic lightson the section of road between Charndon and Twyford as well asa full road closure of a section of School Hill Road.

More detailed information including maps are covered in the PDF file.

If you have any queries or questions, you can contact the HS2 Helpdesk team all day, every day of the year on:
Freephone 08081 434 434
Minicom 08081 456 472
Email  hs2enquiries@hs2.org.uk

Local Proclamation Day on Sunday 11th September

09
September 2022
Local Proclamation Day on Sunday 11th September

Following the death of Her Majesty Queen Elizabeth II there are certain protocols that must be followed.

Tomorrow, Saturday 10th September, the Accession Council will meet to make a formal proclamation of the accession of King Charles III.

On Sunday, the Chair of every council in the land, including Parish Councils, is also required to deliver a similar proclamation at 3:30pm. In Calvert Green, this will happen outside the village hall.

The Parish council will also lay a wreath in the memorial garden, and anyone wishing to leave a floral tribute is welcome to leave it in the memorial garden where they will remain until the day after Her Majesty's funeral.

We are hoping our Book of Condolences will arrive in time for Sunday, but we will communicate when and where it will be available after Sunday.

Local update following the death of the Queen

09
September 2022
Local update following the death of the Queen

We are waiting for confirmation, but will soon be communicating details for flower and wreath laying, access to a book of condolences and the formal proclamation. Please bear with us.

There is also an official online book of condolences at https://www.royal.uk/send-message-condolence

Thanks to the CGCA

09
September 2022
Thanks to the CGCA

Calvert Green Parish Council would like to thank Calvert Green Community Association and volunteers for its quick action last night to remove the flags attached to lamp posts throughout the village as a mark of respect on the death of the Queen.

Queen Elizabeth II, 1926 - 2022

08
September 2022
Queen Elizabeth II, 1926 - 2022

A statement on behalf of Calvert Green Parish Council.
We are deeply saddened to hear of the death of Her Majesty the Queen. She has gracefully and dutifully served for 70 years and was held in great affection and respect by her country.
It is particularly sad that her death comes during her Platinum Jubilee year when the country has been celebrating her long reign.

We send our deep condolences to the Royal Family on behalf of the residents of Calvert Green.

As a mark of respect, and sorrow, we will arrange for flags to be removed from lamp posts and will arrange for a Book of Condolence to be available.

Phil Gaskin
Chairman, Calvert Green Parish Council

8th September 2022.

Piling works on FCC land

19
August 2022
Piling works on FCC land

HS2 Infrastructure Maintenance Depot (IMD) Presentation

HS2 Infrastructure Maintenance Depot (IMD) Presentation
08
August 2022
HS2 Infrastructure Maintenance Depot (IMD) Presentation

Notice of HS2 early works School Hill Bridge August 2022

29
July 2022
Notice of HS2 early works School Hill Bridge August 2022

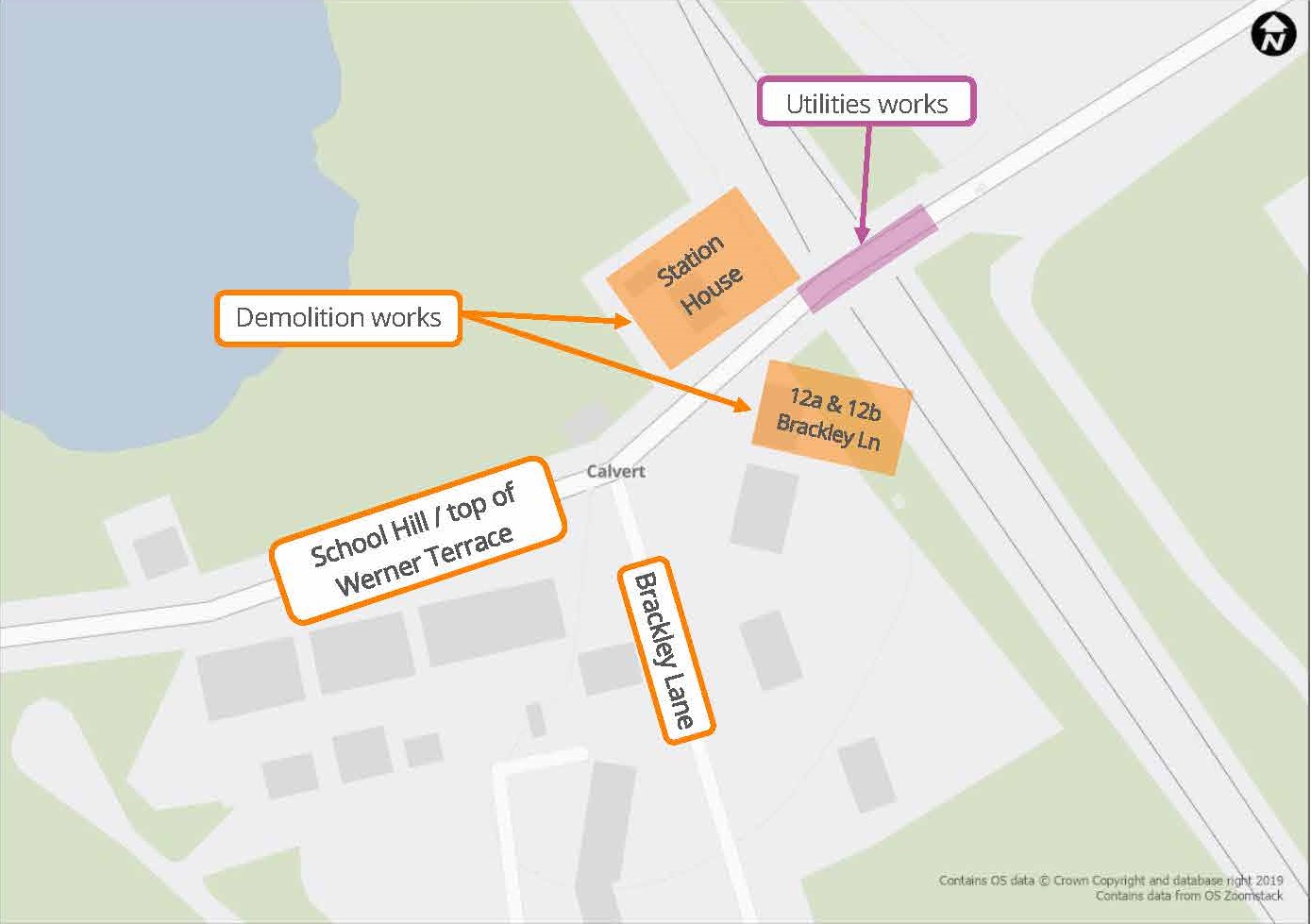

From the middle of August 2022, HS2 will be demolishing the following properties on School Hill / top of Werner Terrace
• Station House
• 12a & 12b Brackley Lane

The attached document covers this work and its impact

HS2 traffic management in August/September

29
July 2022
HS2 traffic management in August/September

A section ofGawcott Road will have traffic managementin the form of two-way traffic lightsfromSaturday13 August to Sunday11 September
2022. During the week, Monday to Thursday, traffic management will be overnight between 8.00pm and 6.00am.
During the weekends, traffic management will be active 24/7 from 8.00pm Fridayto6.00am Monday.
Portway Road will have temporary traffic management for two days in the form of traffic lights on Monday 15 August and 16 August 2022.

You can contact our Helpdesk team all day, every day of the year on:
Freephone: 08081 434 434
Minicom: 08081 456 472
Email: hs2enquiries@hs2.org.uk

HS2 Road Closure update

14
July 2022
HS2 Road Closure Update

The following update was provided by EKFB (HS2 main contractor in our area):

Road closure and disruption to the community: EKFB will not move to the next phase in our road closure programme until both bridges (Addison Road and Twyford Approach Bridge) are fully open to the public. EKFB will then present a detailed programme of phased road closures (with animated slides) for the remainder of 2022 and 2023. Hence, this presentation will therefore be made at the September CALM meeting (date to be advised).

Twyford Approach bridge : this is progressing well and is scheduled to re-open in late August as previously communicated. The central section of the works is complete other than white-lining; the Western section is due to have the surface laid during the first week of August; the Eastern section requires the completion of utility works (end of July), then completion of drainage works (end of July/early August) prior to road surfacing work. In short, we are ‘on schedule’.

Addison Road bridge:this is also progressing well and the only issue creating a risk to delivery is the return of badgers to a former sett, this having been carefully monitored before being closed in 2021. We cannot permanently (and legally) remove the sett until 5th August. The central and northern section of the temporary new road is nearing completion, the Southern section cannot be completed until after 5th August (providing the badgers do not re-habit by digging around/under the fencing). The target completion date remains w/c 15th August.

As always, please raise any incidents, complaints or out-of-hours queries to the HS2 helpdesk on 08081 434 434 or via HS2Enquiries@hs2.org.uk. A copy to engagement@EKFB.com is very helpful as we can sometimes action a response prior to the issue being allocated to EKFB by helpdesk colleagues.

CALM Meeting 14/07/2022

14
July 2022
CALM Meeting 14/07/2022

CALM Meeting 16/06/2022

16
June 2022
CALM Meeting 16/06/2022

Chairman's Report 2022

31
May 2022
Chairman's Report 2022

Update on Brackley Lane works

18
April 2022
Update on Brackley Lane works

Neighbourhood Plan Summary

13
April 2022
Neighbourhood Plan Summary

HS2 Noise Polution Works Notice

08
April 2022
HS2 Noise Polution Works Notice

On Saturday 9th and Sunday 10th April, EKFB will be disassembling the old Calvert railway gantry equipment. These works are expected to take two days to complete.
Due to the nature of these works, there may be some loud bangs. The formal notice below includes further information, along with a detailed schedule.

If you have a question about HS2 or itsworks, please contact the HS2 Helpdesk team on 08081 434 434 or email hs2enquiries@hs2.org.uk

HS2 mobile visitor centre visit on Tuesday 26th April 4pm-7pm

08
April 2022
HS2 mobile visitor centre visit on Tuesday 26th April 4pm-7pm

The HS2 mobile visitor centre will be visiting Calvert Green on Tuesday 26th April between 4pm and 7pm. It will be parked in the Village Hall car park.You will be able to meet EKFB staff and HS2 team members to find out more about the project in our area, see progress so far; and see maps and plans of the project.

If you have a question about HS2 or its works, please contact the HS2 Helpdesk team on 08081 434 434 or email hs2enquiries@hs2.org.uk

EKFB HS2 local newsletter

03
March 2022
EKFB HS2 local newsletter

HS2 related utility works at Werner Terrace and Brackley Lane, Calvert

09
February 2022
HS2 related utility works at Werner Terrace and Brackley Lane, Calvert

East West Rail Newsletters Winter 2022

06
February 2022
East West Rail Newsletters Winter 2022

Calvert Area Local Meeting (CALM) - HS2 and EWR 27/1/22

27
January 2022
Calvert Area Local Meeting (CALM) - HS2 and EWR 27/1/22

Overnight highway improvement works, Station Road, A41 Quainton

10
January 2022
Overnight highway improvement works, Station Road, A41 Quainton

HS2 is completing junction improvement works at the A41 and Station Road. To minimise daytime disruption to the A41, the A41 will be closed overnight. Works are estimated to take five weekday nights to complete but are weather dependant.

Due to possible weather influence a two-week period has been allocated to the work between the 24 January to the 6 February 2022 between the hours of 7pm and 6am (including weekends). Outside of these times and in the event of bad weather the A41 will remain open under traffic light control.

A traffic diversion route will be in place (see enclosed map). Only Emergency services will be given access through the road closure.

You can contact the HS2 Helpdesk team all day, every day of the year on:

Freephone 08081 434 434

Minicom 08081 456 472

Email HS2enquiries@hs2.org.uk

Calvert Area Local Meeting (CALM) - HS2 and EWR 16/12/2021

16
December 2021
Calvert Area Local Meeting (CALM) - HS2 and EWR 16/12/2021

Council makes ‘Brown Before Green’ pledge to prioritise brownfield site development

07
December 2021
Council makes ‘Brown Before Green’ pledge to prioritise brownfield site development

Council makes ‘Brown Before Green’ pledge to prioritise brownfield site development

Buckinghamshire Council has begun preliminary work on the Local Plan for Buckinghamshire, which will shape the future for the county’s planning and development. And as it does so, it is clearly stating a policy pledge: Brown Before Green.

The Local Plan for Buckinghamshire will seek to balance the need for new homes and related facilities with the need to protect the natural environment and preserve the special character of the county’s towns, villages and countryside. Brown Before Green is the Council’s policy pledge to use brownfield sites – land that has previously been built on – whenever possible when meeting the development needs that will be set out in the new Local Plan.

And to ensure that there are as many brownfield sites as possible available for redevelopment, the Council is asking Buckinghamshire residents, businesses and landowners to get in touch and provide details of any previously developed sites that might be suitable for addition to the county’s list of possible sites.

Gareth Williams, Buckinghamshire Council Cabinet Member for Planning & Regeneration, said: “Creating a Local Plan for Buckinghamshire will be a demanding and challenging process, as we seek to ensure a strong local economy and good quality of life for all sections of our community, while at the same time looking after our natural environment and local heritage.

“As we get to work on the Local Plan, we’re making a policy pledge we’re calling Brown Before Green. This is an undertaking that we will seek to use brownfield sites for building development under the new Local Plan whenever possible, and only identify greenfield sites when there is no alternative.

“And to support us in this, we’re asking for the help of Bucks residents, businesses and landowners. If you’re aware of any previously built on sites that you feel might be appropriate for redevelopment, then let us know! We’ve opened a new portal that will let you enter details and a geographical location of potential sites so that we can investigate further.”

To find out more about Brown Before Green, go to: www.buckinghamshire.gov.uk/brown-before-green

To submit information on a potential brownfield site, please go to: https://bit.ly/3oo4rHz

Calvert HS2 green tunnel proposal

19
November 2021
Calvert HS2 green tunnel proposal

Here are documents and responses relating to Calvert Green Parish Council's attempt to revisit a green tunnel as the railway passes Calvert.

Update to HS2 A41 closures near Quainton

14
November 2021
Update to HS2 A41 closures near Quainton

East West Rail Newsletters Autumn 2021

04
November 2021
East West Rail Newsletters Autumn 2021

HS2 Brackley Lane Closure 10/11/21 - 21/12/21

04
November 2021
HS2 Brackley Lane Closure 10/11/21 - 21/12/21

Brackley Lane will be closed from 10th November until 21st December.Please ignore the current signs which state that the closure starts on 8th - it is wrong and will be changed.Children travelling by school bus should have been notified by Buckinghamshire Council about the changes to affected bus stops from 10th November.Attached is an HS2 document covering this along with other closures and road works

Sandhill Road, Middle Claydon reopens on Monday 8th November

25
October 2021
Sandhill Road, Middle Claydon reopens on Monday 8th November

Sandhill Road, Middle Claydon will reopen on Monday 8 November.

HS2 A41 Overnight Closures in November

25
October 2021
HS2 A41 Overnight Closures in November

To safely complete the junction improvement works at the A41 and Station Road and minimise daytime disruption to the A41 it is necessary to close the A41 overnight. Works are estimated to take five weekday nights to complete but are weather dependant. Due to possible weather influence a two-week period has been allocated to the work between the 15 November to the 19 November 2021 and 22 November to 26 November 2021 between the hours of 7pm and 6am. Outside of these times and in the event of bad weather the A41 will remain open under traffic light control. A traffic diversion route will be in place (see attached map). Emergency services will be given access through the road closure.

Community Engagement Document - October 2021

11
October 2021
Community Engagement Document

HS2/EWR Marshals hit the streets of Bucks

08
October 2021
HS2/EWR Marshals hit the streets of Bucks

HS2/EWR Marshals hit the streets of Bucks

Due to the significant increase in the HS2 /East West Rail works across the county, Buckinghamshire Council has appointed its first HS2/EWR Marshals to help residents impacted by the projects.

They will be the Council’s eyes and ears on the ground addressing highways and planning issues caused by HS2 Ltd, the EWR Alliance and their appointed agents, contractors and subcontractors.

Mark Rann and Steve Hall took up their roles this summer and are quickly getting to know the key issues across Bucks and building relationships with interested parties.

A major part of their role will be to respond to complaints and queries relating to HS2 and EWR’s traffic management, highways activities and planning issues. They will ensure that all works and site operations are completed within the agreed plans, programmes and timescales; issue instructions and directions to the contractors to minimise disruption and inconvenience to the public.

Mark and Steve said: “This is going to be a really exciting and challenging job. We will be having direct contact with HS2 Ltd, EWR Alliance and their appointed agents and contractors, with the aim of minimising impact on the highway network and inconvenience to the public; liaising directly with statutory utility companies and other parties to ensure the Highway Authority obligations for street works and traffic management are met.

We are looking forward to representing the Council at public meetings, liaising with Councillors, Parish Councils, local forums, residents and businesses.”

Councillor Peter Martin, Cabinet Member with responsibility for HS2 and EWR said: “We have identified the need to invest further into our handling of HS2/EWR activities for the benefit of our communities.

We are delighted that Mark and Steve have now joined us. This is an extremely important role and with them both out in the field, they will help us resolve the many issues our residents are experiencing as a result of the works of HS2 and EWR and ensure we do all we can to mitigate the impact and activities of these projects.”

Mark and Steve can be contacted by email on ewrandhs2enquiries@buckinghamshire.gov.uk

East West Rail Traffic Update

08
October 2021
East West Rail Traffic Update

Parish Council response to HS2 schedule 17 planning application

08
October 2021
Parish Council response to HS2 schedule 17 planning application

HS2 advance works notification of Phase 3 of utility diversion works Calvert

28
September 2021
HS2 advance works notification of Phase 3 of utility diversion works Calvert

Ahead of the main HS2 works construction of the railway, the existing Calvert rail overbridge requires demolishing and then rebuilding. This bridge contains a number of existing utility services that require diverting under the HS2 railway and the existing railway line.

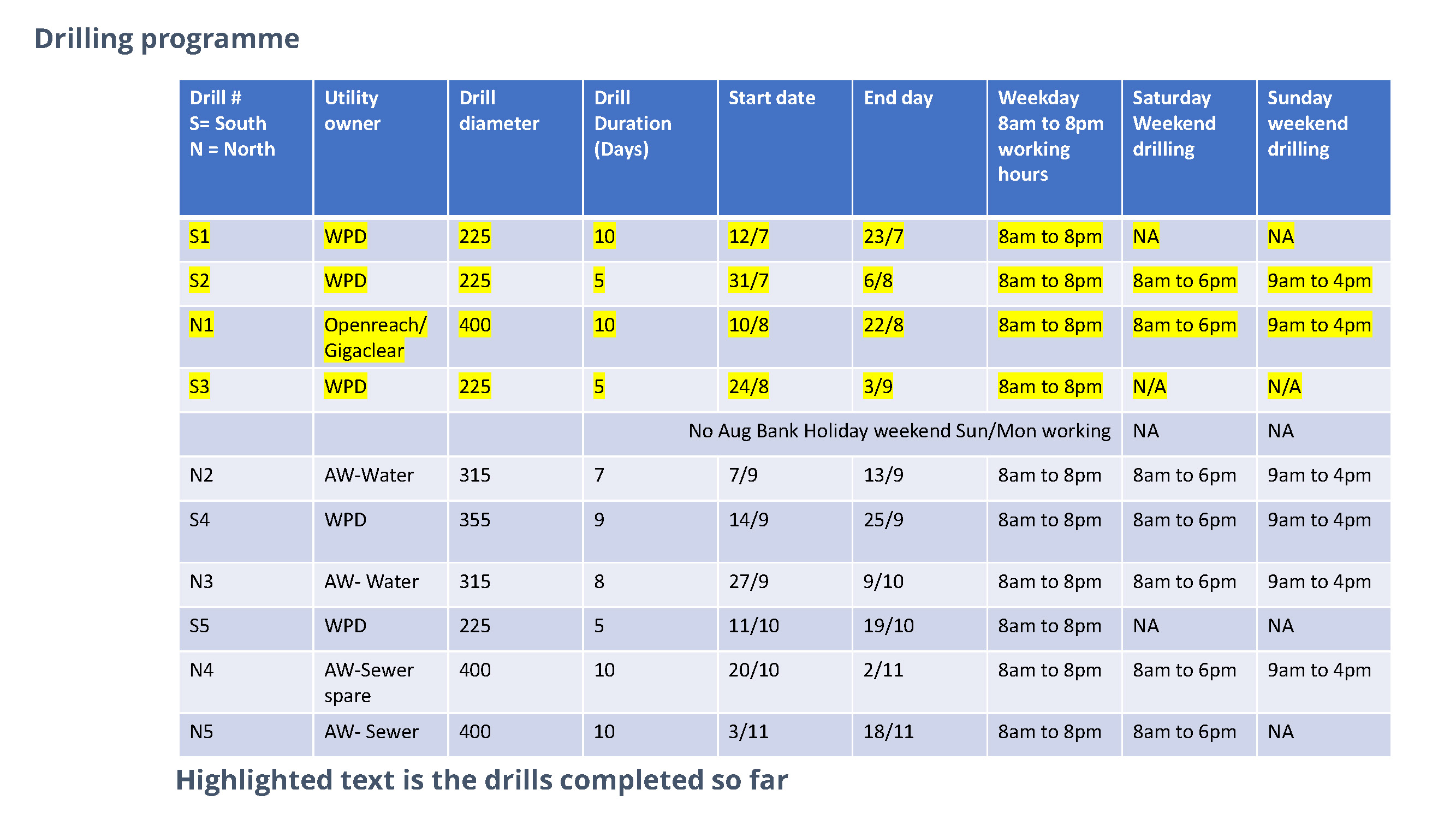

Fusion are currently halfway through its phase 2 programme of drilling works, however due to a combination of wet weather (early August 2021) and the ground conditions this has delayed the works. The remaining drilling works are now programmed to be completed by the end of November 2021 and will involve continued low impact weekend drilling works.

Due to the closure of Addison Road over bridge by Network Rail, the original intended diversion route for Calvert Road has now changed. An alternative route is proposed and is shown below and contained on the attached notification which is subject to final consents and approvals.

HS2 HGV construction traffic will not be permitted along the diversion route. Ahead of the diversion route being used, East West Rail will be undertaking highway repairs.

Access to the Calvert Road compound for HS2 deliveries will continue to be accessed along the approved HS2 route of Werner Terrace.

Network Rail is continuing to investigate the Addison Road over bridge. Further updates with be provided by Network Rail to the local community representatives in the coming weeks.

Subject to final consents, Calvert Road (and bridge) will be closed from Tuesday 12 October 2021 to Tuesday 9 November 2021. The road will be closed 24/7 where a local diversion route will be in place. The road closure is to allow for the open supported trenches to connect into the existing utilities.

Following this work, Brackley Lane will be closed in two sections to allow residents to have access. Brackley Lane will be closed from the 10 November to 21 December 24/7 where a local diversion will be in place. The road closure is to allow for the open supported trenches to connect into the existing utilities.

Due to the closure of Addison Road, the attached community notice has been issued to reflect the amended diversion route.

HS2 e-Newsletter Updates

HS2 e-Newsletter Updates
22
September 2021
4

Addison Road immediate closure

15
September 2021
Addison Road immediate closure

Addison Road was planned to be closed by HS2 from the 20th September, but unfortunately the decision has been made o close Addison Road at the railway bridge with immediate effect on the grounds of public safety.Monitoring of the structure will continue, and Network Rail will carry out further structural investigations in due course on their asset. The road is now closed and further communications will be sent out as soon as possible. I attach a map.

Conversion of Petanque pit to a garden area

13
September 2021
Conversion of Petanque pit to a garden area

Back in 2019, the parish council decided to convert the current petanque pit to a tranquil garden area. Due to all of the impact from HS2 on our area we decided to ask HS2 if they would be prepared to give something back to our community. They agreed and designers were sent out and shared two design options. This was shared with the commuinity at a parish council meeting in 2019 and it was agreed we would go with the above plan. Work was due to start in September 2019 but unfortunately we were let down at the last minute. The pandemic hit in 2020 and the parish council continued to pursue this work.

After help from our MP, Greg Smith we have now been able to move things forwards and HS2 has agreed to start work soon. The idea is the garden will be a tranquil area for reflection and remembrance. We have also asked that the children's painted stone catapillar be incorporated into the edging of the garden to provide a poignant reminder of the pandemic challenges we all faced during 2020 and 2021.

Although we had hoped to use the benches made from HS2 felled oak trees as a statement in the garden, due to the condition of the benches, we will look to deploy them elsewhere and provide more traditional hardwood benches instead. We will communicate when work will commence once we know the schedule, but it is hoped that the work will be completed this year.

Parliamentary debate on HS2

13
September 2021
Parliamentary debate on HS2

The Petitions Committee has scheduled a debate on a petition relating to HS2. It is being heard this evening. There is a link to the live feed/recording at https://youtu.be/Au6TZYztPdg

Our MP, Greg Smith was one of the MPs debating HS2.

There are also a number of videos that have been released in advance of this session. Here are a couple:

https://www.youtube.com/watch?v=uV-Q-MuKhXQ

https://youtu.be/fzs6VgvJ_0c

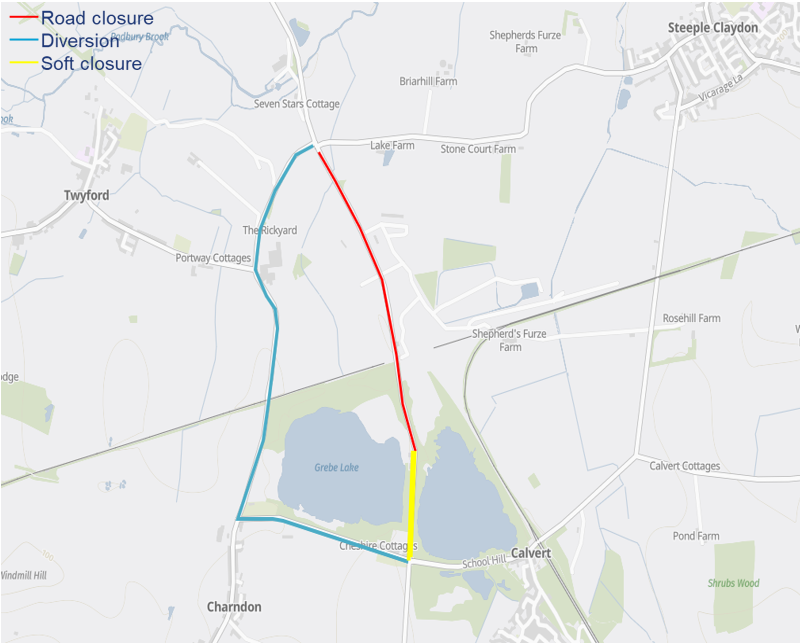

HS2 Brackley Lane Closure 22nd September and Calvert Railway Bridge overnight on 16th September

13
September 2021
HS2 Brackley Lane Closure 22nd September and Calvert Railway Bridge overnight on 16th September

Following on from the trial holes that were undertaken on Brackley Lane and Calvert Road HS2 need to do some further PAS 128 surveys to confirm the utilities in the highway. To undertake the works safely we will need to close Calvert Road at night on Thursday 16 September 2021 from 8pm to 6am. Buses and emergency services will still be given access.

Brackley Lane will be closed on Wednesday 22 September 2021 from 9am to 5pm. Access will be given to the bus, school bus, emergency services and Brackley Lane residents.

East West Rail Roadworks update

13
September 2021
East West Rail Roadworks update

Please find documents relating to upcoming East West Rail roadworks in the area.

Updated HS2 Drilling Works on Brackley Lane

Updated HS2 Drilling Works on Brackley Lane
13
September 2021
Updated HS2 Drilling Works on Brackley Lane

Here is the updated schedule for the HS2 underground drilling works schedule

Bus Service Consultation

28
August 2021
Bus Service Consultation

Buckinghamshire Council is currently preparing a Bus Service Improvement Plan (BSIP), to be published later in the year. The BSIP will outline the ambitions of both the Council and local bus operators on how bus services can be improved in order to attract more passengers and reduce local car journeys. This in turn will help to inform the formation of an Enhanced Partnership between the Council and bus operators in 2022.

As you may already be aware, Buckinghamshire Council is undertaking a survey with both bus users and the wider community to determine which measures for improving bus services to prioritise. Please be aware that this survey closes on 3 September 2021.

https://yourvoicebucks.citizenspace.com/integrated-transport/busstrategy2021/

Buckinghamshire Council is also open to other written feedback on priorities for bus improvements, including after 3 September. This should be sent to the Transport Strategy team mailbox: transportstrategy@buckinghamshire.gov.uk

Road Closure on Steeple Claydon Road (Twyford Bridge)

28
August 2021
Road Closure on Steeple Claydon Road (Twyford Bridge)

HS2 will be carrying out Ground Investigation (GI) works along a section of Steeple Claydon Road (also known as West Street) in the vicinity of the bridge by Portway Farm.
The road will be temporarily closed  for two days, starting Tuesday 7 September. This closure will only be introduced during off peak hours (Tuesday 7 September to Thursday 9 September between 9.00am and 3.00pm) with a diversion in place.

If you have a question about HS2 or itsworks, please contact the HS2 Helpdesk team on 08081 434 434 or email hs2enquiries@hs2.org.uk

Calvert Area Local Meeting (CALM) - HS2 and EWR 26'08/21

26
August 2021
Calvert Area Local Meeting (CALM) - HS2 and EWR 26'08/21

East West Rail Newsletter

20
August 2021
East West Rail Newsletter

Here is a link to East West Rail's summer newsletter: https://mailchi.mp/eastwestrail/keeping-you-connected-4771762

East West Rail Road Closures

20
August 2021
East West Rail Road Closures

Here is a breakdown of road closure notices from East West Rail which relate to roads in the local area.

HS2 and EWR meetings this week

20
August 2021
HS2 and EWR meetings this week

It's been a busy week for HS2 and EWR meetings. I attended the East West Rail Community Forum on Monday which was chaired by our MP, Greg Smith. East West Rail has addressed many issues raised in the previous meeting but many new items were raised including the state of local roads and the maintenance schedule. https://www.gregsmith.co.uk/news/greg-chairs-east-west-rail-action-plan-update-meeting

Tuesday included a meeting with other local parish council representatives and the HS2 Minister where we were able to raise local concerns. https://www.gregsmith.co.uk/news/greg-shows-hs2-minister-local-hs2-failings-first-hand. This meeting was arranged by our MP, Greg Smith and follows his work to have our community hear at the Transport Select Committee in January. https://www.google.com/search?q=phil+gaskin+hs2&client=firefox-b-d&source=lnms&tbm=nws&sa=X&ved=2ahUKEwjogdCBisDyAhVioFwKHecNCWAQ_AUoAXoECAEQAw&biw=2560&bih=1287

And on Wednesday (along with the Section 17 detailed design planning application for HS2 in our area), I met with other local parish council representatives with a group of HS2 representatives led by Ambrose McGuire. This was a very productive meeting organised by Roger Landells (Chair of Twyford parish council) and was held at Calvert Green Community Centre. Many issues were discussed and actions taken by HS2.

HS2 Section 17 Planning Application

20
August 2021
HS2 Section 17 Planning  Application

HS2 has finally submitted its Section 17 planning application for the detailed design of the railway as it passes by Calvert Green. This includes the new line height (which is about the same as the existing railway line), noise barrier design, landscaping and planting and structures including the replacement railway bridge and a new green bridge.There are 100 documents in the planning application but they are accessible at https://publicaccess.aylesburyvaledc.gov.uk/.../search.do... and entering 21/03275/HS2 into the search box.The parish council will review and respond but everyone has the right to comment on this website.

Further Information on Concrete Batching Plant

20
August 2021
Further Information on Concrete Batching Plant

The parish council has always objected to the HS2 Concrete Batching Plant on the edge of the village. Although we were unsuccessful at stopping or moving it, we have for some time asked for further information to share with residents. Please find attached a document which covers its purpose and health and safety information.

Gawcott Road Weekend Closure

20
August 2021
Gawcott Road Weekend Closure

Attached is a road closure notice from HS2 regarding the closure of Gawcott Road from Friday 20th August to Monday 23rd August

Calvert Area Local Meeting (CALM) - HS2 and EWR 29/07/2021

29
July 2021
Calvert Area Local Meeting (CALM) - HS2 and EWR 29/07/2021

HS2 Drilling Schedule on Brackley Lane

29
July 2021
HS2 Drilling Schedule on Brackley Lane

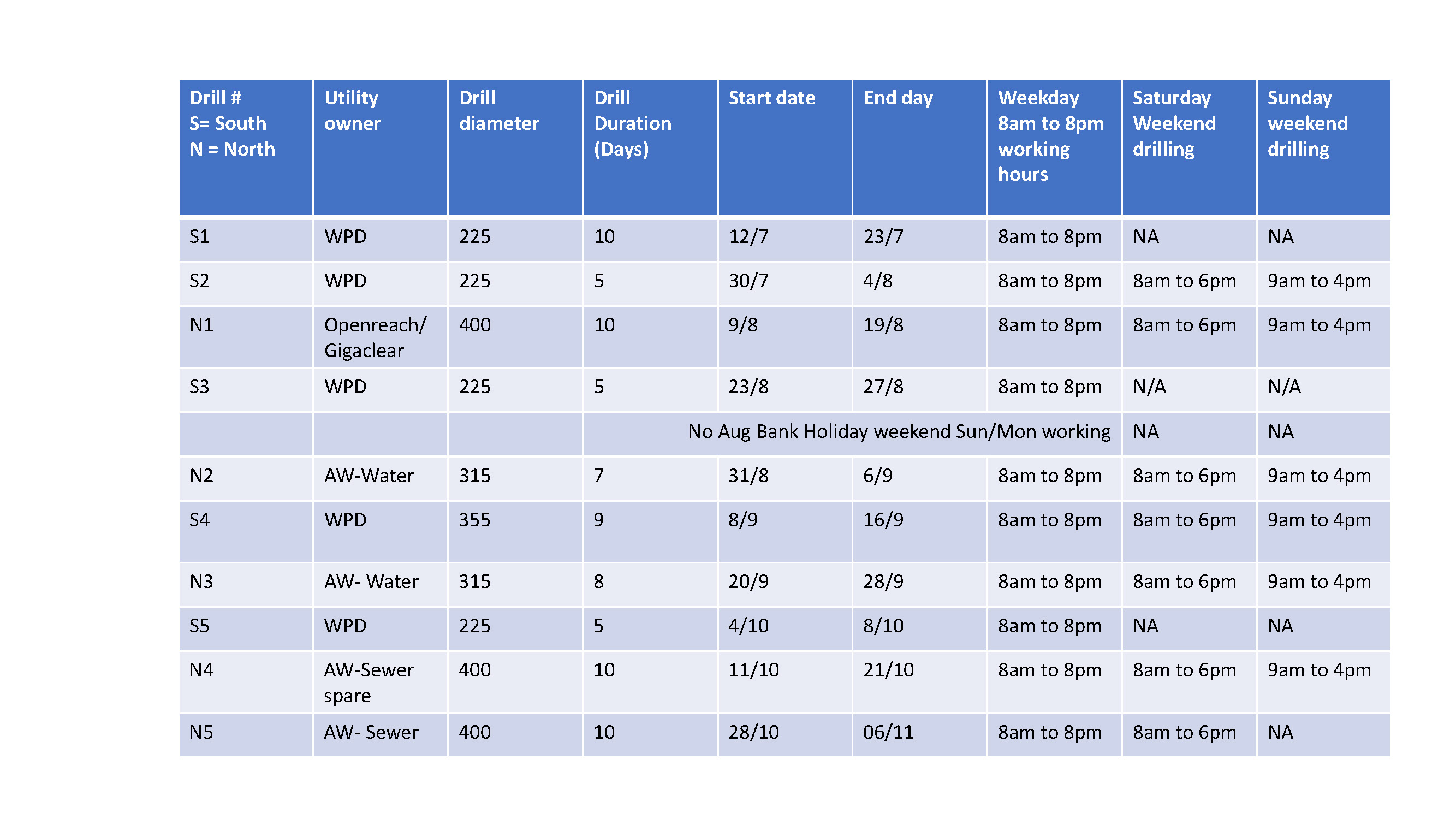

This is the provisional works schedule for HS2 drilling activity on Brackley Lane. The actual drilling is taking place from the other side of the railway line but it will involve HGV movements on Brackley Lane over the coming months. Please note that some weekends will be worked but we have been promised that no activity will be carried out over the August Bank Holiday weekend. The South drill is the compound outside the landfill gates and the North drill is just past the Cotwolds Way / Brackley Lane junction.

Calvert Area Local Meeting (CALM) - HS2 and EWR 15/07/2021

15
July 2021
 Calvert Area Local Meeting (CALM) - HS2 and EWR 15/07/2021

Presentation and rolling actions from CALM meeting 15/7/2021

HS2 taking over FCC railhead for 2 months (August and September 2021)

HS2 taking over FCC railhead for 2 months (August and September 2021)
15
July 2021
HS2 taking over FCC railhead for 2 months (August and September 2021

Information from Buckinghamshire County Council Planning on HS2 take over of FCC railhead for unloading and stockpiling of ballast.

Latest East West Rail Traffic Updates

23
June 2021
Latest East West Rail Traffic updates

The latest East West Rail traffic management schedules are below.

For more information on the upcoming road closures please visit: one.network.

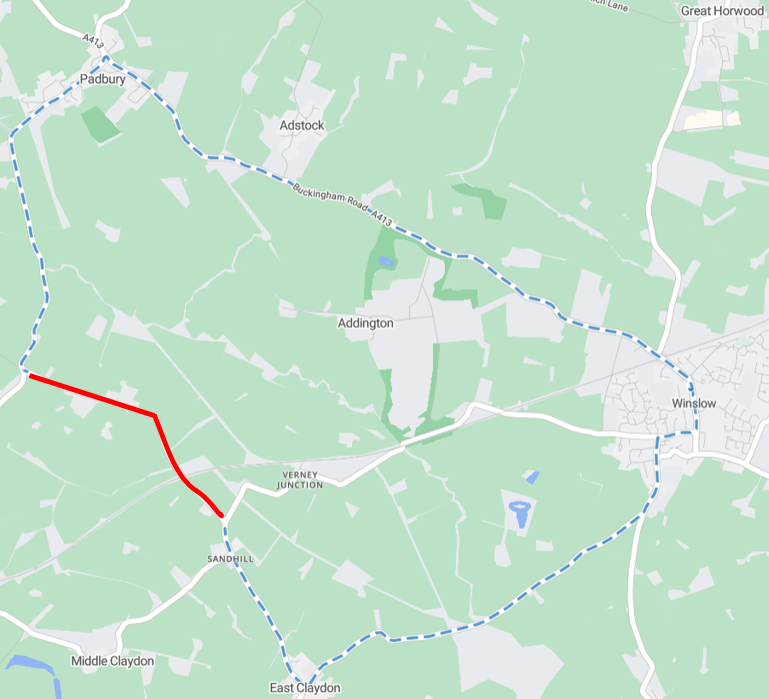

Update on Sandhill Road Closure

18
June 2021
Update on Sandhill Road Closure

Feedback Survey on East West Rail

18
June 2021
Feedback Survey on East West Rail
Quadrangle, an independent market research agency has been employed by the East West Railway Company (EWR Co) to get a better insight on how residents feel about the project that will link Oxford to Cambridge by rail.

They are currently running a survey to better understand the impact of the current construction works on residents in the affected areas as well as anything that could be improved.

As Calvert Green is one of these impacted areas, this survey is relevant for Calvert Green residents. Please use the survey link below to share your feedback on experience of the East West Rail construction works so far.

The survey link is: https://survey.euro.confirmit.com/wix/p267496757784.aspx

The survey will close on 28th June.

Calvert Area Local Meeting (CALM) - HS2 and EWR 17/06/2021

17
June 2021
Calvert Area Local Meeting (CALM) - HS2 and EWR 17/06/2021

Rather than keep sharing HS2 and East West Rail presentations in one repository we are sharing the documents associated with each meeting here

Weekend Road Closures Stratton Audley And Poundon

09
June 2021
Weekend Road Closures Stratton Audley And Poundon

Please be advised that EWR highway works, from Poundon To Stratton Audley, previously scheduled for the weekend of 5th and 6th June have been postponed.

These works are now scheduled for the weekend of 12th 13th 19th and 20th June to carry out highway repairs and resurfacing works. EWR will be working along Stratton Audley Road, Poundon through to Stratton Audley Park, Stratton Audley.

These roads will be closed from 7:00 am to 7:00 pm on the above dates whilst EWR are working.

Please be advised that East West Rail Alliance has also carried out emergency repairs between Herds Hill and Ox Lane to repair the most hazardous parts of the roads and will return to the area at a later date to carry out further repairs.

Clarity on Brackley lane parking restrictions

08
June 2021
Clarity on Brackley Lane parking restrictions

Here is a document from Fusion - HS2's enabling works contractor clarifying the parking restrictions on Brackley Lane.

Chairman's report 2020/21

20
May 2021
Chairman's report 2020/21

Upcoming HS2 Main Works Virtual 1-1 Engagement Events

18
May 2021
Upcoming HS2 Main Works Virtual 1-1 Engagement Events

Upcoming HS2 Main Works Virtual 1-1 Engagement Events

HS2's main contractor EKFB is hosting virtual community engagement events. The next 1-1 events for the Quainton and Calvert area are on Tuesday 8 June, from 3pm-7pm.Anyone interested can book 20 minute slots here: https://www.eventbrite.co.uk/e/149192277117

FAQs

Who are the events for?

For members of public, landowners, local residents or businesses who have queries about HS2 works in their area. The entire construction area is split into 5 smaller areas, you can view the full list of events at https://www.eventbrite.co.uk/o/hs2-community-events-27591966155

How are they structured?

The 1-1 meetings are held on Microsoft Teams and each session is 20 minutes long. Attendees can submit themes or questions ahead of the session to ensure EKFB can prepare information and maps in advance, and have the right specialists on hand, whether it be a member of Engagement team, Traffic & Transport or our Environmental teams. As Covid-19 restrictions are eased, there may be scope for face-to-face meetings later in the year.

If you have any questions on these events or any suggestions, please email Engagement@EKFB.com

Council keeping a close eye on the new HS2 concrete batching plant at Calvert

12
May 2021
Council keeping a close eye on the new HS2 concrete batching plant at Calvert

Communities encouraged to ‘go wild’ in competition to support wildlife conservation

08
May 2021
Communities encouraged to ‘go wild’ in competition to support wildlife conservation

Local residents, community groups and organisations in and around Aylesbury Vale are being invited to get creative and take part in an exciting wildlife conservation competition in partnership with Berkshire, Buckinghamshire & Oxfordshire Wildlife Trust (BBOWT), Chiltern Rangers and the mental health charity Lindengate, the competition is open to individual residents, community groups, town and parish councils and schools. Anyone with an interest in protecting and enhancing local wildlife and environmental habitats. Our area is included in this competition.

Entries can be as small as a window box or container to a larger green space or garden. Entrants are asked to design and create a wildlife habitat around the three core elements needed to sustain wildlife: water, food and shelter.

Ian Thompson, Buckinghamshire Council's Corporate Director for Planning, Growth and Sustainability, explained more: “This competition offers a great way for local groups and individuals to help us work in partnership to enhance and expand our green spaces and gardens as havens for wildlife. We are keen to work with local people to protect existing habitats and create new ones for the benefit of the whole community.”

Competition entries of all shapes and sizes are encouraged. Ian Thompson continued: "We're asking people to be as creative and inventive as they can be with this competition, whatever the size of the space you have. Transforming these spaces into welcoming environments for wildlife has benefits for both the natural world but also the health and wellbeing of the whole community."

A range of prizes are up for grabs for different entrants. This includes bird boxes, bug hotels, and membership to BBOWT for residents, tours of College Lake for schools, Lindengate vouchers for parish and town councils and BBOWT training sessions for community groups.

To find out more and register your interest visit the website.

East West Rail Traffic updates

30
April 2021
East West Rail Traffic updates

The latest East West Rail traffic management schedules are below.

For more information on the upcoming road closures please visit: one.network.

Concrete Batching Plant

30
April 2021
Concrete Batching Plant

The HS2 concrete batching plant (by Calvert railway bridge) was not included in any of the original HS2 plans or documentation and the land was originally earmarked as a satellite compound and materials stockpile. The parish council petitioned in parliament against this plan as an existing local wildlife site, and in such close proximity to residential properties when the main HS2 Infrastructure Maintenance Depot is planned nearby.
We asked that other locations be considered, but were unsuccessful in changing this.
However, soon after royal assent the use of this land was changed to a concrete batching plant. We instantly objected and have continued to oppose it.

There are many types of concrete batching plant. The one identified for Calvert is classed as a temporary ancillary structure and is planned for 5 years but could be kept until up to 2 years after HS2 completion under the act.

This video shows how it will operate. The Calvert plant will be much bigger with 4 silos. This type of concrete batching plant ensures that cement powder is transferred in sealed pipes.

More information is contained in the PDF document below. Buckinghamshire Council Environmental Health is satisfied on the safety of this plant although the parish council has asked EKFB for more information on health and safety which we will share as we receive it.

Dust from HS2

30
April 2021
Dust from HS2

Many of you will have seen the posts on social media regarding the lack of dust supression mitigation by HS2. The parish council with support from Angela Macpherson at Buckinghamshire Council have been raising this for some time.
EKFB (Main works contractor) is currently compiling a complete response but have replied to say they are carrying out work to minimise dust generation and do have dust suppression measures in locations where the activity has potential to cause dust.
Their dust monitoring results have not identified that the activity has triggered defined levels but they are getting a more detailed response on this aspect from specialists to explain this aspect better.

We are hoping that the environmental health team will also perform monitoring to corroborate these results.
EKFB has also supplied the below photos to show dust mitigation measures they have deployed.

Calvert North Railhead_Dust Suppression System.jpgIMG-20210426-WA0012.jpgWhatsApp Image 2021-04-29 at 14.47.53.jpeg

HS2 tracking and netting of animals

27
April 2021
HS2 tracking and netting of animals

It was brought to our attention that HS2 contractors had placed what could be considered to be poison near badget setts in the surrounding area along with netting to prevent animals from accessing certain areas. We contacted HS2 who provided the following statement:

"HS2 ecologists are looking at the movements of badger families in the Calvert area, to better understand the number of different ‘clans’ and where they are living in the area, to aid with mitigation ahead of construction of the railway. The monitoring includes ‘bait marking’ using coloured pellets which are mixed with food such as peanuts and syrup outside burrow entrances. The badgers then eat these pellets, and excrete them somewhere else nearby. This helps ecologists determine clan territory extent and different colours are used for each clan.

The specific locations where HS2 are carrying out bait marking cannot be signposted due to risks of disturbance to badger setts, as they are a protected species under the Badger Act 1992. There is no risk of harm to pets or animals as a result of these ecological monitoring activities.

The mesh has been put around the base of the tree to ensure badgers do not dig to create a sett."

We asked that signage is used to highlight to users of footpaths that this is safe for dogs. HS2 won't identify the actual locations by placing signage but have agreed to consider signage highlighting this on footpaths.

Prison Consultation

26
April 2021
1

Letter from Martin Tett to Rt Hon Grant Shapps MP on HS2 impact on highways

14
March 2021
Letter from Martin Tett to Rt Hon Grant Shapps MP on HS2 impact on highways

Updated Addison Road HS2 Closure Info

19
February 2021
Updated Addison Road HS2 Closure Info

Please find attached a copy of the advance works notification detailing the upcoming works Fusion, EKFB and Western Power Distribution will be undertaking along Addison Road from the 8 March to 12 March 2021. Addison Road will be closed from 8am till 6pm where the local diversion route will be in place. Outside of these times Addison Road will be open as normal.

EWR Newsletters 2021

04
February 2021
EWR Newsletters 2021

Sunday Times article on HS2 in the area

31
January 2021
Sunday Times article on HS2 in the area

The Sunday Times published an article about HS2 construction in the Calvert Green area on Sunday 31st January 2021. This was following evidence heard by the Transport Select Committee on 6th January.

The article is available at https://www.thetimes.co.uk/article/hs2-protests-swampy-and-his-burrowers-dig-in-for-a-long-siege-hz0gsjrsk although requires a subscription.

There is a video available on YouTube https://www.youtube.com/watch?v=Jv8eqgw_qG0

HS2 works notices 2021

28
January 2021
HS2 works notices 2021

HS2 works notices from Fusion (Enabling Contractor) and EKFB (Main Contractor) which relate to works in the Calvert area

HS2 Weekend Works February and March 2021

28
January 2021
HS2 Weekend Works February and March 2021

As part of HS2's woodland translocation works its contractor has identified a requirement to undertake works outside of the Code of Construction Practice, CoCP, working hours. This includes some Saturday and Sunday working in February and early March due to constraints around working adjacent to FCC and Network Rail Operations, not permitted during normal working hours.

These works have been approved under the section 61 consent of the Control of Pollution Act, 1974 from Buckinghamshire Council.
Working hours will take place between: Saturday 08:00 – 16:00 (CoCP permitted hours until 13:00) and Sunday 09:00 – 16:00.

The works will take place on the following weekends (weather dependant):

• Saturday 6 and Sunday 7 February 2021
• Saturday 13 and Sunday 14 February 2021
• Saturday 20 and Sunday 21 February 2021
• Saturday 27 and Sunday 28 February 2021
• Saturday 6 and Sunday 7 March 2021

Addison Road Closure for HS2 works

25
January 2021
Addison Road Closure for HS2 works

Please find below a copy of the advance works notification detailing the upcoming works Fusion, EKFB and Western Power Distribution will be undertaking along Addison Road from the 8 February to 12 February 2021. Addison Road will be closed from 8am till 6pm where the local diversion route will be in place. Outside of these times Addison Road will be open as normal.

You can contact the HS2 Helpdesk team all day, every day of the year on:

Freephone: 08081 434 434
Minicom: 08081 456 472
Email: hs2enquiries@hs2.org.uk

Leader of Buckinghamshire Council calls out HS2 Limited’s attempts to keep local residents informed

18
January 2021
Leader of the Council calls out HS2 Limited’s attempts to keep local residents informed

Leader of the Council calls out HS2 Limited’s attempts to keep local residents informed

19 Jan 2021, 9 a.m.

Martin Tett, Leader of Buckinghamshire Council, has written to the Chairman of the Government’s Transport Select Committee (TSC) about the lack of effective monitoring HS2 Limited does of its works and contractors in Buckinghamshire.

Martin said: “I urge the Select Committee to insist that HS2 Ltd and its contractors do as they said they would when they set out their proposals to Parliament. Faced with the delivery phase of this unwanted project, the least we should expect is considerate, well communicated implementation. However, despite the assurances from HS2 that they will be a “good neighbour” we are not currently experiencing that. Instead HS2 issues are diverting tax-payers’ resources away from delivering vital services during a pandemic, as we are having to deal with countless local issues which are caused, and not adequately addressed, by HS2 Ltd and its contractors.

The Council has historically opposed the HS2 project and continues to do so for many valid reasons. It dissects the county and provides no tangible benefits to Buckinghamshire. We have all the dis-benefits of a large-scale construction project and none of the benefits, with the damage being done to our environment and the visual impact completely irreversible.”

At the meeting of the TSC on 6 January, it’s second six monthly oral evidence session on the progress of HS2, evidence was given by Phil Gaskin, Chairman of Calvert Green Parish Council, an area hugely impacted by HS2. He stated “that there is no quick and simple way of resolving issues with HS2 Ltd.”

Both Greg Smith MP for Buckingham and Mr Gaskin raised the need for independent oversight of the project and suggested the implementation of local sheriff style appointments, to be told by Mark Thurston, HS2’s CEO that these roles were already in existence. No-one has seen these officers in Buckinghamshire.

Councillor Tett added: “On this basis I urge the Select Committee to ensure that there is effective monitoring of the contractors and HS2 Ltd’s decisions to implement the project differently to the proposals set out to Parliament, and for Buckinghamshire Council to be appropriately re-imbursed for the additional pressures which the project implementation is putting on the authority.”

Extract from Buckinghamshire Council's post at https://www.buckinghamshire.gov.uk/news/leader-of-the-council-calls-out-hs2-limiteds-attempts-to-keep-local-residents-informed

Emergency Food Provision

18
January 2021
Emergency Food Provision

Planning Applications for Dunsty Hill Farm

08
January 2021
1

Following the housing survey from the developer who owns Dunsty Hill Farm, they have now submitted two planning applications. Neither of these applications relate to affordable housing which was previously discussed. Instead they relate to alterations to an existing barn and a change of use for the farm to catagory C1 for hotel flexible use.

"Highbarrow Holdings is seeking to obtain approval for the re-use of two of the redundant barns at Dunsty Hill Farm but this does not affect our plans for the Rural Exception Site application. We intend to submit the Rural Exception Site application in early 2021.

We obtained a lawful development certificate for the smaller barn in the summer, the current application is for minor works to make it fir for a B1c use, the objective is to have 3 small light-industrial units there.

We will also be looking to obtain ‘prior approval’ for the larger steel barn to use it as either an apart-hotel or commercial use. This prior approval application will confirm that the use is ‘permitted development’. If this is approved, we will then submit a subsequent application for external works to make that barn fit for purpose.

The re-use of the agricultural buildings is actively encouraged by national planning legislation – measures are therefore in place to allow such uses without the need for a traditional planning application"

The Parish Council will be responding to these applications, but the planning applications are accessible everyone and we would encourage you to review the information and submit your own comments.

Planning Application 20/04204/APP is for external alterations to an existing barn: https://publicaccess.aylesburyvaledc.gov.uk/online-applications/applicationDetails.do?activeTab=documents&keyVal=QL0JR4CLL3T00

Planning Application 20/04431/COUAF is for the change of use to C1: https://publicaccess.aylesburyvaledc.gov.uk/online-applications/applicationDetails.do?activeTab=documents&keyVal=QM3P4DCL0RH00

You will be able to comment online using these links.

You can access Buckinghamshire Council's Planning Portal at https://publicaccess.aylesburyvaledc.gov.uk and search for any application in the area.

Neighbourhood plan Steering Group

06
January 2021
1

NOTIFICATION

CALVERT GREEN PARISH COUNCIL

RE: NEIGHBOURHOOD PLAN STEERING GROUP

Response deadline: Friday 8th February 2021

This is a formal notification and will be posted on the PC Website, the village notice board and on the Calvert Residents FB site. If you are interested in joining the Steering Group for the development of the Neighbourhood Plan. Please send an email to clerk@calvertgreenparish.co.uk with your name and contact details.

Anyone resident within the community can note their interest. The final Steering Groupwill be limited to 7 people: 4 residents,1 member of the Calvert Green Community Association and 2 members of the Parish Council. Depending on the number of responses received, there will be an independent and fair method used to finalise the Steering Group. We will also be guided throughout the process by an external expert consultant.

BACKGROUND: The Neighbourhood Plan

Calvert Green Parish Council are planning to create a Neighbourhood Development Plan (also known as a Neighbourhood Plan) for our local area. A Neighbourhood Plan is a formal document which sets planning policies at a local level and so, it’s important that our local community is involved in each stage of the Plan’s creation. Step 1of this process is to define the ‘Neighbourhood Area’ that the Plan will cover and apply to the Council for approval.

STEP 1: Neighbourhood Area Application and Consultation: Details about the neighbourhood area application (now closed) can be found on the Your Voice Bucks website including the parish application letter, including reasoning why we wish to include parts of Charndon parish and the Chardon parish agreement to the inclusion: https://yourvoicebucks.citizenspace.com/planning/calvertgreen-ndp-are

If you have any questions please contact: Clerk@calvertgteenparish.co.uk

Happy New Year!

CGPC

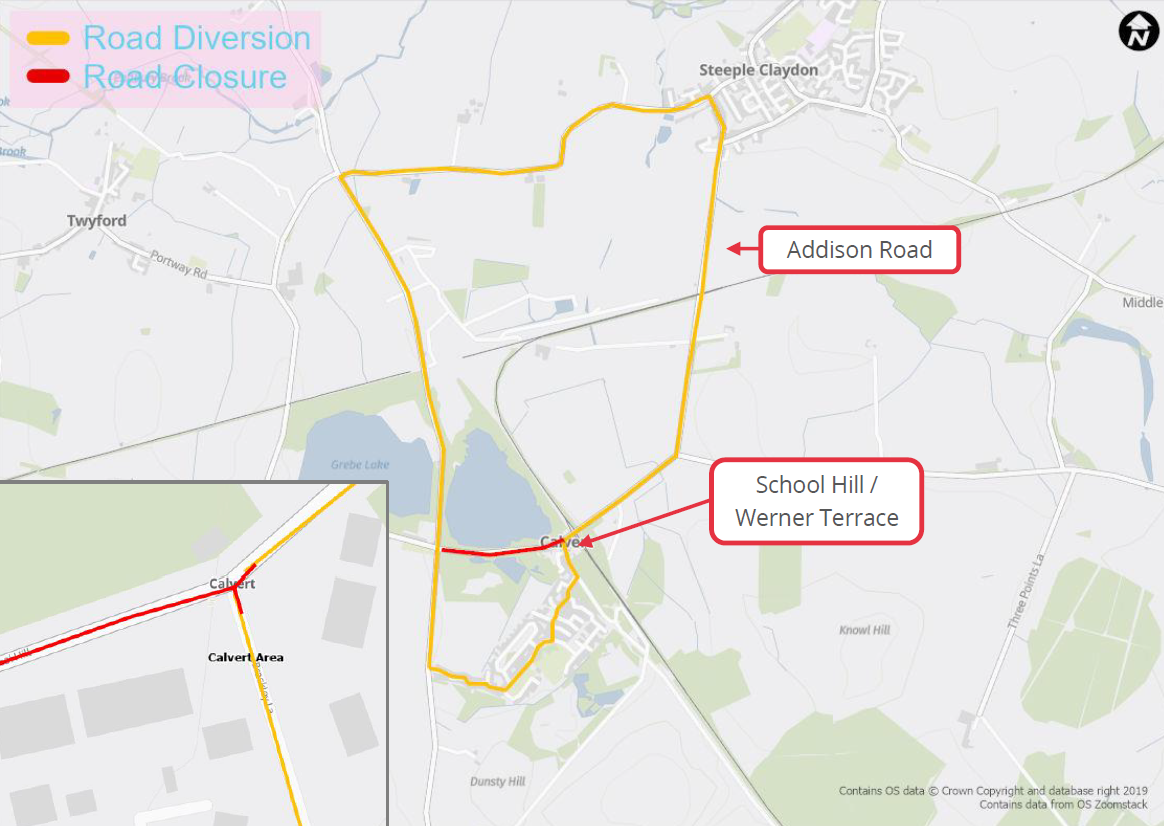

Upcoming EWR road closures in our area

30
December 2020
1

Attached are two documents identifying upcoming road closures in our area. Please note that the closures in the Buckinghamshire specific document are likely to severely affect access to Padbury.

New Prison Consultation

30
December 2020
1

The newly proposed prison (between Grendon Underwood and Edgcott) extension consultation period has been extended until 29th January 2021. Updated information is below including a flyer from Edgcott Parish Council.

To visit the consultation website go to: https://consult.justice.gov.uk/digital-communications/potential-newprison-in-buckinghamshire

To have your say, visit: https://consult.justice.gov.uk/digital-communications/potential-new-prison-in-buckinghamshire/consultation/intro/

Neighbourhood Plan Consultation Update

15
December 2020
1

I am getting tired and angry about the misinformation and scaremongering that is going on. If you recently received a letter through your letterbox about Calvert Green Parish Council's neighbourhood plan submission, please ignore it because consists of complete lies. In fact the neighbourhood plan is actually the only real opportunity we have as a parish to influence any future development.
Calvert Green is surrounded by land owned by developers. If you look around the edges, you will see lots of road stubs that were deliberately incorporated. A neighbourhood plan is the only fight we have to influence development in our area. I use the word influence because Calvert Green Parish Council is only one of a number of consultees and Buckinghamshire Council may or may not take note of its comments in its decision on planning applications.
Neighbourhood planning gives communities direct power to develop a shared vision for their neighbourhood and shape the development and growth of their local area. They are able to choose where they want new homes and have their say on what those new buildings should look like and what infrastructure should be provided, and grant planning permission for the new buildings they want to see go ahead.
The farmed land to the left of the main entrance to Cotswolds Way is owned by David Wilson who shared plans for over 100 houses a few years ago. It sits in Charndon parish which means we have little influence over any development in this area - even though it would connect to our existing village. This is the reason why we have agreed with Charndon Parish Council to include this as part of our neighbourhood plan's designated area. Without it, we have absolutely no control over decisions made on this land. Whether we like it or not, at some point they will submit planning applications, as will the Dunsty Hill developers and FCC who have also considered housing plans.

If the neighbourhood plan is accepted, the next step is to setup a steering group to ensure we represent the true views of the community and we will be looking for volunteers to join.

All these points have been discussed at previous parish council meetings and are covered in the minutes which are available from the parish council website www.calvertgreenparish.co.uk. Parish Council meetings are open to the public and there is always an opportunity to ask questions. We also make sure that everything is properly explained. I wish that the few people in our community who constantly attack the parish council would actually attend parish council meetings and understand the facts, rather than share inaccurate information. We are all volunteers and bound by strict governance which means that everything we do is transparent and published.

The neighbourhood plan consultation is still open and accessible at https://yourvoicebucks.citizenspace.com/planning/calvertgreen-ndp-area. You are within your rights to object to the additional land included, but if you do so, you risk us having no control over any planning decision adjoining our village. Everything is covered in the formally published document below.

Phil Gaskin

Chairman, Calvert Green Parish Council.

HS2 Traffic Information Guide

14
December 2020
1

Traffic information update from EKFB (HS2 main works contractor). Please note that this does not include Fusion (HS2 enabling contractor) or East West Rail.

Meeting With Martin Tett 09/12/20

09
December 2020
1

On Wednesday morning, at our invitation Martin Tett, Leader of Buckinghamshire Council, accompanied by Angela Macpherson, our Councillor, took an extended drive around the local area affected by the combined effects of HS2 and East West Rail (EWR).

The purpose of the trip was to bring Mr Tett up to speed on the local situation prior to a meeting with a representative of Steeple Claydon PC and the Chairs of the other local Parishes, Calvert Green, Charndon and Twyford at Twyford Village Hall. During this meeting we expressed our concern about the behaviour of the contractors working for HS2 and EWR in terms of respecting the agreed conditions for construction, the effect of the additional traffic, speeding by contractors’ vehicles, failure to keep the road surfaces free of mud and their effect on the road surfaces and verges.

We asked that processes be put in place to monitor these issues and ensure, as far as possible, that senior management of the two promoters take appropriate actions to bring their contractors and sub contractors to heel. The Council have the benefit of being able to speak with the senior management, an advantage denied mere Parish Councils despite both promoters’ protestations of operating to high standards of resident engagement. Finding some way of improving behaviour is, in our opinion, vital in avoiding any dangerous incidents as work becomes more intense.

We also asked for the County’s support in our quest to relax the terms of use of the Mitigation Fund negotiated on our behalf by Mr Tett so that the monies can be spent on projects of immediate benefit to our communities rather than only being applied to environmental mitigation which will depend, to a greater or lesser degree, on the completion of designs for HS2 in the area which still appear to be some considerable time away.

All in all a useful meeting which has now involved the highest political levels of the Council with the opportunity to repeat at, maybe, quarterly intervals. Hopefully, this will start to make a difference to the challenging times which we face whilst the two railways are completed.

Additionally it is worth reporting that on 6th January there will be a Transport Select Committee session at the HoC at which the HS2 Minister and the CEO of HS2 appear. Our MP, Greg Smith, who is a member, has arranged for a short presentation created by the four Parishes to be made by Phil Gaskin of Calvert Green PC. This will demonstrate the cavalier manner in which both railways are being constructed. This will give the MPs some ammunition with which to hold HS2 and the DfT to account in the second part of the session. We hope that they take the opportunity.

Parish HS2/EWR presentation to Greg Smith MP

27
November 2020
1

Copy of presentation on behalf of Calvert Green, Charndon, Steeple Claydon and Charndon parish councils

Response to CPG-RAG Doordrop letter

23
November 2020
1

23rd November 2020.

As chairman of Calvert Green parish Council (CGPC), I feel it necessary to respond to a letter that was circulated over the weekend purporting to be on behalf of Calvert Green Parish Residents Action Group (CGP-RAG).

I must firstly explain that this letter was deliberately omitted from parish councillor's letterboxes and I am deeply concerned by the content and by the fact that survey data was used to personally identify individuals, in contradiction of GDPR policy. I have previously had to complain about the harassment of parish councillors on their own doorsteps by a member of CGP-RAG which is another misuse of personal identifiable information. The content of this letter that was circulated was brought to our attention by concerned residents on Sunday 22nd November.

All but one parish councillor signed the CGP-RAG petition and while some did feel pressured to do so, it also puts us in a difficult position because, after taking legal advice, this affects our ability to make a majority balanced decision based on declarations of interest. Therefore, criticism of parish councillors who, on reflection (and on the record) actually felt pressured to sign the petition undermines their ability to represent the community's views.

I'll start by setting the scene. Calvert Green, whether we like it or not, is surrounded by land already owned by developers - none of which is green belt. The Vale of Aylesbury local Plan (VALP) which is soon to be approved (at County Level) will protect us from major development for 5 years. CGPG is in the process of formulating its own Neighbourhood plan which will include engagement with the community. This plan, when complete will afford us some protection by influencing future planning applications. The Dunsty Hill developers are working outside of these current planning restrictions by using a rural exception scheme - to demonstrate a need for affordable housing. At this stage, no planning application has been submitted.
While Parish Councils are consulted on all parish planning applications., any views expressed by the Parish Council will be taken into account by the Planning Authority before a decision is made, providing the points made are relevant to the determination of a planning application. However, the final decision is made by the Planning Authority (Buckinghamshire Council), not the Parish Council.

For years, CGPC has supported the best interest of our community and has successfully objected to several planning applications from developers surrounding us. As with all developer interaction, CGPC identifies the lack of amenities, public transport and existing percentage of affordable housing. We then encourage developers to engage with the community on their plans prior to any planning application - to give parishioners the ability to formulate their own considered response. This was done in respect of the Dunsty Hill proposal.

In January 2019 we objected to a previous planning application opinion for approximately 400 homes, including 4 and 5 storey blocks of flats on Dunsty Hill. In the interest of transparency, I am sharing a map of our community showing all the previous development proposals to date. All of which have currently come to nothing - not that they won't come up again because many of you will be aware of the various planning consultancy schemes such as http://www.5thstudio.co.uk/site/assets/files/1308/5thstudio-cal-project_page.pdf and https://www.aylesburyvaledc.gov.uk/sites/default/files/page_downloads/160905%20FINAL%20DRAFT%20VALP%20Reps%20-%20Verney%20Junction.pdf. CGPC has challenged these grand schemes and was assured by Buckinghamshire County Council that no master plan is at play.

Calvert Developer Land lr.jpg

At our last parish council meeting, CGPC agreed to setup a steering committee with CGP-RAG. CGPC is still waiting for dates from CGP-RAG to proceed. Furthermore, CGPC arranged to meet with CGP-RAG and our MP Greg Smith but were told by CGP-RAG not to attend. For the record, CGPC is very much willing to work with CGP-RAG and our parishioners to ensure the best for our community. Our position with the developers is entirely to ensure the community would get the best deal should any development be approved and it is clear that we neither support nor object at this stage because no planning application has been made. It is common for parish councils to discuss with developers on the needs of the community - such as allotments or play areas. This does not set any precedent for support. While a petition of names is useful, it does not carry the same weight as individual letters of objection and we would encourage everyone to respond if a planning application is submitted, whether you support or object to the proposal.

As a parish council, we are here to represent the whole community. The Dunsty Hill farm developers sent their own petition to every household - and of the respondents, 50% were against new affordable homes and 50% were in favour. Now whilst this only represents a small percentage of the community, everyone was given the opportunity to respond and nobody should have been discouraged from responding. There are 402 domestic properties in Calvert Green Parish as well as two businesses. However, we are attached and integrated with the original hamlet of Calvert (Brackley Lane and Werner Terrace) where there are several more properties which were rightly included in the developer's consultation.

Amongst other things, CGPC is also engaged with East West Rail and High Speed Two and has successfully won concessions after petitioning in parliament - not that this will minimise the blight our community will suffer over the coming years during construction, but it has at least provided us with funding to mitigate the impact of these projects.

All your parish councillors are unpaid volunteers who also work full time and give up their time to support the community. I encourage you to join us for our parish council meeting at 7:30pm on Thursday 3rd December. It will be a Zoom meeting and the connection details will be shared via CGPC website at www.calvertgreenparish.co.uk and via Facebook and the village notice board.

Phil Gaskin
Chairman, Calvert Green Parish Council

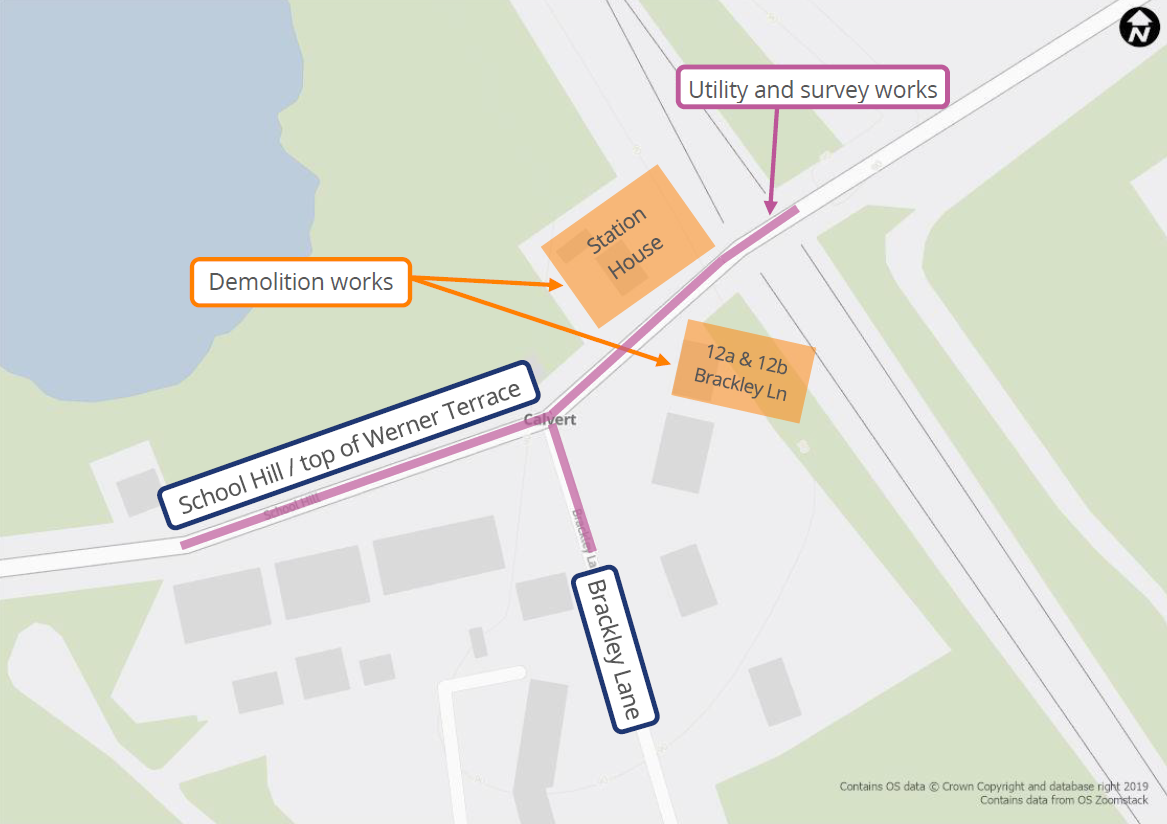

HS2 Additional Vegetation Clearance on Brackley Lane

18
November 2020
1

The date of the clearance works has now changed by a week. The works will now start on Monday 7th December to Friday 11th December 2020.

HS2 upcoming works schedule

18
November 2020
1

HS2 webinar tonight on works in Calvert area (register before 4pm)

18
November 2020
1

There is an HS2 webinar tonight covering works in the Calvert area where you can ask questions to the HS2 team. You can register to attend by using the link below.

Calvert works update on Wednesday 18 November 6:00-7:00pm

Please note registration will close two hours before the webinar starts.

HS2 Presentations 2020/2021

10
November 2020
HS2 Presentations 2020/2021

East West Rail Presentations 2020

10
November 2020
12

Calvert Green Neighbourhood Area Consultation

10
November 2020
1

Calvert Green Parish Council are planning to create a Neighbourhood Development Plan (also known as a Neighbourhood Plan) for their local area. A Neighbourhood Plan is a document which sets planning policies at a local level and so, it’s important that the local community is involved in each stage of the Plan’s creation. The first step of this process is to define the ‘Neighbourhood Area’ that the Plan will cover and apply to the Council for approval.
The proposed Calvert Green Neighbourhood Area covers the whole of Calvert Green Parish Council area and a small part of the neighbouring parish of Charndon.

If you would like to find out more about this, please access the Your Voice Buck’s website.
https://yourvoicebucks.citizenspace.com/planning/calvertgreen-ndp-area/
The consultation takes place between 9th November and the 20th December 2020

HS2 works notices 2020

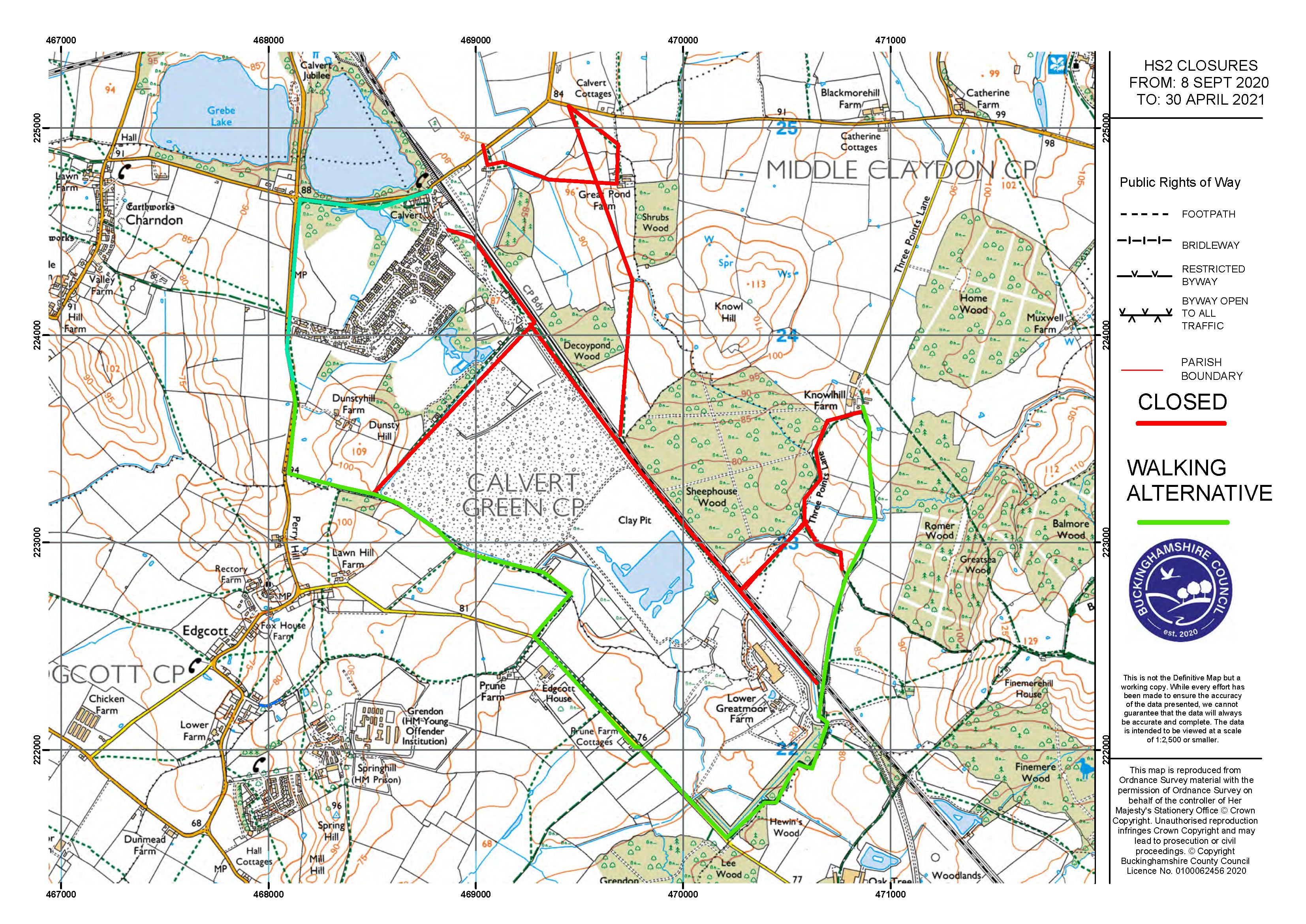

10
November 2020
4

HS2 works updates in the Calvert area..

You can contact the HS2 Helpdesk on Freephone 08081 434 434 or by Email: HS2enquiries@hs2.org.uk. You can also view additional work notifications in our local area at www.hs2inbucksandox.co.uk

CGPC HS2 Petitions

10
November 2020
4

Temporary Closure of Bridle Path

10
November 2020
3

Update from Buckinghamshire Council re Bonfire night 2020

03
November 2020
1

Dunsty Hill Development proposal 2020

13
October 2020
1

Play parks

13
October 2020
2

New play Parks maps and downloadable questionaire

Chairman's report 2020

04
June 2020
Chairman's report 2020

HS2 Community and Environment Funding

01
January 2020
1

Community engagement document

1

Community engagement document

1

Download the community engagement document here

Traffic Control and suspension of parking on Brackley Lane

Traffic Control and suspension of parking on Brackley Lane

HS2 will be installing 24 hour 3-way temporary traffic lights on Brackley Lane with the junction of Cotswold Way, between 6th and 8th September 2021 and then outside the Concrete Batching plant between 8th and 10th September.This will affect parking on Brackley Lane and Cotswolds Way between 6th and 8th September.

RE: Buckinghamshire Local Plan – Statement of Community Involvement and Brownfield Call for Sites

RE: Buckinghamshire Local Plan – Statement of Community Involvement and Brownfield Call for Sites

Buckinghamshire Council is beginning work on its new local plan to cover the period up to 2040. This plan will cover the whole of Buckinghamshire identifying how much development is needed, where it should happen and what it will be like. They are asking for views on two important building blocks of the plan.

The first is the Statement of Community Involvement (SCI) which sets out how we engage with our residents and businesses, when we make planning decisions either on planning applications or developing our plans. We are consulting on a draft SCI between February 16th and March 22nd.

The second is the Brownfield Call for Sites, sites which we believe will have an important part to play in meeting our development needs in the future. We are asking landowners, developers, house builders, community groups, parish councils and members of the public to respond about brownfield sites that could be included in the new plan for development.

To find out more and let Buckinghamshire Council know what you think please see the Your Voice Bucks (https://yourvoicebucks.citizenspace.com).

Neighbourhood plan consultation

1

Calvert Green Neighbourhood Area Consultation

Calvert Green Parish Council are planning to create a Neighbourhood Development Plan (also known as a Neighbourhood Plan) for their local area. A Neighbourhood Plan is a document which sets planning policies at a local level and so, it’s important that the local community is involved in each stage of the Plan’s creation. The first step of this process is to define the ‘Neighbourhood Area’ that the Plan will cover and apply to the Council for approval.

The proposed Calvert Green Neighbourhood Area covers the whole of Calvert Green Parish Council area and a small part of the neighbouring parish of Charndon.

Proposed Neighbourhood Area boundary

© Crown copyright and database right. All rights reserved (100056280) 2020,© Crown copyright and database right. All rights reserved (100056280) 2020,© Crown copyright and database right. All rights

If you would like to find out more about this, please access the Your Voice Buck’s website.

https://yourvoicebucks.citizenspace.com/planning/calvertgreen-ndp-area/

The consultation takes place between 9th November and the 20th December 2020

Neighbourhood plan

2

Coming soon

HS2 Code of Construction Practice

11

You can contact the HS2 Helpdesk on Freephone 08081 434 434 or by Email: HS2enquiries@hs2.org.uk. You can also view additional work notifications in our local area at www.hs2inbucksandox.co.uk

Map of Parish boundaries

1

Dunsty Hill Development proposal 2018

2
